Quick Answer

Most barndominiums take 6 to 12 months to build from the moment you break ground, though the full project timeline — including planning, permitting, and design — typically runs 9 to 18 months from start to finish. The exact duration depends on the size of the structure, whether you use a prefabricated kit or a fully custom design, local permitting requirements, and contractor availability in your area.

Key Takeaways

  • A standard barndominium build takes 6 to 12 months of active construction; the full project timeline, including permitting and planning, is typically 9 to 18 months.
  • Permitting and zoning approval alone can add 1 to 4 months to your schedule, depending on your county and state.
  • Kit-based barndominiums are generally faster to build than fully custom designs, sometimes shaving 2 to 4 months off the construction phase.
  • Weather, contractor availability, supply chain delays, and financing approval are the most common causes of schedule overruns.
  • Rural areas often face longer permitting timelines but fewer contractor scheduling conflicts than suburban markets.
  • Owner-builders can reduce labor costs but typically extend the construction timeline by 20 to 40 percent compared to experienced general contractors.
  • Barndominiums are well-suited to families, couples, and single individuals — the floor plan flexibility makes them adaptable to nearly any household size.
  • Custom barndominiums with complex floor plans, high-end finishes, or unconventional layouts can take 14 to 24 months from concept to move-in.

What Exactly Is a Barndominium and How Is It Different from a Regular House

A barndominium is a metal or steel-frame building that combines living quarters with open workshop, garage, or storage space under one roof. Unlike a traditional stick-frame home, a barndominium uses a post-frame or rigid-frame steel structure as its primary skeleton, which changes both the construction process and the timeline significantly.

The key differences from a conventional house include:

  • Structure: Steel or metal frame versus wood stud framing.
  • Speed of framing: A steel shell can be erected in days rather than weeks.
  • Open floor plans: Fewer load-bearing interior walls mean more flexible interior layouts.
  • Dual-purpose design: Many barndominiums include a garage bay, workshop, or barn area alongside the living space.
  • Exterior finish: Metal panel siding is standard, though board-and-batten, brick, and stone veneers are increasingly common.
  • Cost profile: Material costs differ significantly from traditional construction (see the cost section below).

The term “barndominium” is sometimes used loosely to describe any metal building converted into a home, but in current construction practice it most often refers to a purpose-built hybrid structure designed from the ground up as a residence.

How Long Does Each Stage of Barndominium Construction Typically Take

Understanding how long it takes to build a barndominium requires breaking the project into discrete phases. Each phase has its own timeline, and delays in one phase cascade into the next.

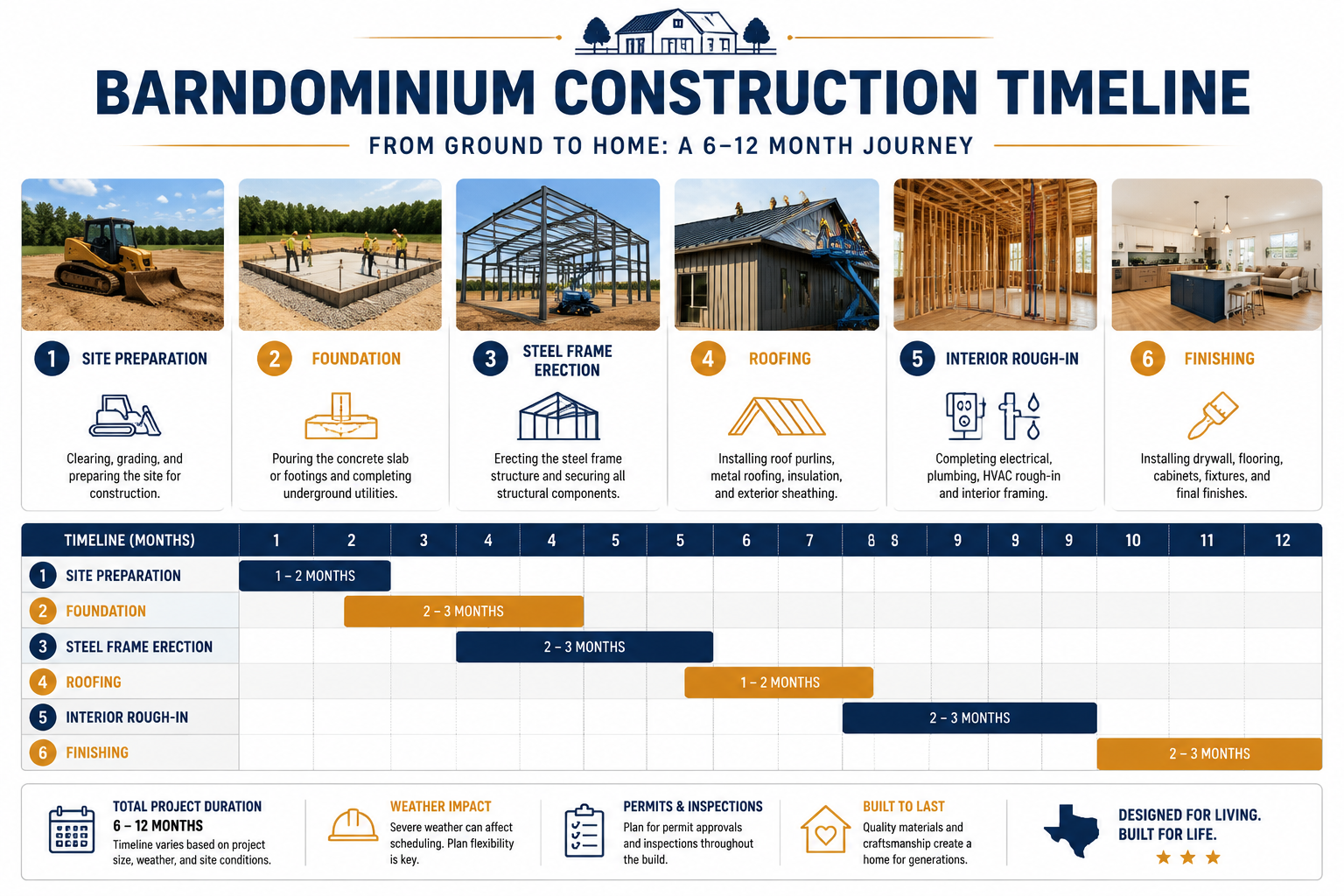

How Long Does Each Stage of Barndominium Construction Typically Take

Here is a realistic phase-by-phase breakdown for a mid-size barndominium (approximately 1,800 to 2,400 square feet of living space):

Phase Typical Duration Key Variables
Design and planning 4 to 8 weeks Complexity of floor plan, architect availability
Permitting and zoning approval 4 to 16 weeks County regulations, completeness of application
Site preparation and clearing 1 to 3 weeks Land condition, acreage, tree removal
Foundation (slab or pier) 2 to 4 weeks Soil conditions, concrete cure time
Steel frame and shell erection 1 to 3 weeks Kit vs. custom, crew size
Roofing and exterior panels 1 to 2 weeks Weather, panel type
Rough-in (plumbing, electrical, HVAC) 4 to 8 weeks Complexity, subcontractor scheduling
Insulation 1 to 2 weeks Spray foam vs. batt insulation
Drywall and interior framing 3 to 6 weeks Square footage, ceiling height
Flooring, cabinetry, and fixtures 4 to 8 weeks Lead times on custom orders
Final inspections and punch list 2 to 4 weeks Inspector availability, number of corrections

Total active construction: approximately 6 to 12 months

A common mistake is treating the design and permitting phases as separate from “the build.” In practice, those early phases eat 2 to 6 months before a single shovel hits the ground, which is why the full project timeline stretches to 9 to 18 months for most owner-builders and general contractors.

How Long Does Permitting and Zoning Approval Usually Take for a Barndominium

Permitting for a barndominium typically takes 4 to 16 weeks, but in some counties it can extend to 6 months or longer. The timeline varies based on local regulations, the completeness of your submitted plans, and whether your property is zoned for residential use.

Key factors that affect permitting speed:

  • Zoning classification: Some rural counties do not have a specific category for barndominiums. You may need a variance or a reclassification, which adds weeks or months.
  • HOA restrictions: Homeowner associations in suburban or semi-rural areas often prohibit metal-sided structures entirely.
  • Engineered drawings: Most counties require stamped engineering drawings for a steel-frame structure. Incomplete submissions are the single most common cause of permitting delays.
  • Septic and well permits: If your property is not on municipal water and sewer, you will need separate permits for a septic system and water well, each of which has its own review timeline.
  • Fire marshal review: In some jurisdictions, a steel building requires a separate fire safety review.

Decision rule: If you are buying land specifically to build a barndominium, verify the zoning classification and speak with the county building department before closing on the property. Discovering a zoning conflict after purchase can add months and thousands of dollars to your project.

How Much Does It Cost to Build a Barndominium Compared to a Traditional Home

A barndominium typically costs less per square foot than a site-built traditional home, though the gap has narrowed as material prices have shifted. According to data compiled by the National Association of Home Builders (NAHB) in their 2023 construction cost survey, the average cost to build a new single-family home in the United States was approximately $153 per square foot for construction costs alone, excluding land.

Barndominium construction costs, based on industry estimates from multiple steel building suppliers and general contractors, typically fall in the following ranges:

  • Basic kit barndominium (shell only): $30 to $60 per square foot
  • Turnkey barndominium with standard finishes: $100 to $150 per square foot
  • High-end custom barndominium: $150 to $250 per square foot or more

The shell of a barndominium (the steel frame, roof, and exterior panels) is often less expensive than traditional framing, but interior finishing costs are comparable to any other residential build. Plumbing, electrical, HVAC, insulation, drywall, flooring, and cabinetry cost roughly the same regardless of whether the outer shell is steel or wood.

Where barndominiums save money:

  • Faster framing reduces labor costs.
  • Metal roofing typically has a longer lifespan than asphalt shingles, reducing long-term maintenance costs.
  • Open floor plans can reduce the number of interior walls and associated framing labor.

Where costs can surprise you:

  • Spray foam insulation, which is often recommended for metal buildings, costs more than batt insulation.
  • Custom steel fabrication for non-standard dimensions adds cost quickly.
  • Financing can be more difficult to secure, and some lenders charge higher rates for non-traditional structures.

What Factors Can Delay or Speed Up Barndominium Construction Time

Several variables directly control how long it takes to build a barndominium. Some are within your control; others are not.

Factors that commonly cause delays:

  • Contractor availability: In high-demand markets, experienced barndominium builders may be booked 3 to 6 months in advance.
  • Material lead times: Steel building kits from major suppliers can have lead times of 8 to 20 weeks depending on order volume and manufacturing capacity.
  • Financing delays: Construction loans require inspections at each draw, and scheduling those inspections adds time.
  • Change orders: Changing the floor plan or specifications mid-construction is one of the most reliable ways to extend a timeline by weeks or months.
  • Subcontractor scheduling: Plumbers, electricians, and HVAC technicians often work across multiple job sites, and gaps in their availability create idle periods on your build.

Factors that can shorten the timeline:

  • Prefabricated kit design: Ordering a standard kit from a reputable supplier means the steel components arrive pre-cut and pre-drilled, reducing on-site fabrication time significantly.
  • Experienced general contractor: A GC who has built barndominiums before knows how to sequence subcontractors efficiently and anticipate inspection requirements.
  • Mild weather during construction: Scheduling your foundation pour and framing for spring or early fall in most U.S. regions reduces weather-related delays.
  • Complete and approved plans before breaking ground: Projects that start construction before all permits are in hand almost always face costly stop-work orders.

How Do Construction Timelines Differ in Rural Versus Suburban Areas

Rural and suburban barndominium builds face different constraints, and the timeline differences are real. In rural areas, permitting is often simpler because zoning regulations are less restrictive, but access to skilled contractors and subcontractors can be limited. In suburban areas, contractors are more available, but zoning restrictions and HOA rules can block a barndominium project entirely or require extensive modifications.

Rural build considerations:

  • Permitting may be faster (some rural counties have minimal building codes).
  • Utility connections (electricity, water, sewer) may require longer runs or alternative solutions such as wells and septic systems, adding 4 to 8 weeks.
  • Contractor travel time to remote sites can increase labor costs and scheduling complexity.
  • Material deliveries to remote locations may require special logistics, particularly for large steel components.

Suburban build considerations:

  • Zoning and HOA restrictions are the primary obstacle — many suburban zones do not permit metal-sided structures.
  • Contractor availability is generally better, which can compress the construction timeline.
  • Utility connections are typically faster and less expensive.
  • Neighbors and local planning boards may raise objections that trigger additional review periods.

General rule: If you want to build a barndominium in a suburban setting, budget an additional 2 to 4 months for zoning review and potential variance applications compared to a rural build.

What Kind of Weather Conditions Can Impact the Barndominium Building Schedule

Weather is one of the most underestimated variables in any construction timeline. For barndominiums, the phases most vulnerable to weather delays are the foundation pour, steel erection, and exterior panel installation.

  • Concrete and temperature: Concrete should not be poured when temperatures fall below 40 degrees Fahrenheit or rise above 90 degrees Fahrenheit without special measures. In northern states, this limits foundation work to roughly April through October.
  • Steel erection and wind: Crane operations for steel frame erection are typically halted when sustained winds exceed 20 to 25 miles per hour. High-wind regions (the Great Plains, coastal areas) can see multiple weather days per week during certain seasons.
  • Rain and site conditions: Prolonged rain turns unimproved sites into mud, which can halt deliveries and equipment movement for days at a time.
  • Extreme heat: In the southern United States, summer heat can limit outdoor work hours, effectively reducing productive construction days per week.

Practical advice: Build a 10 to 15 percent weather buffer into your construction schedule. If your contractor estimates 8 months of active construction, plan for 9 months before you make commitments that depend on a move-in date.

Can I Build a Barndominium Myself or Do I Need Professional Contractors

Owner-builders can and do build barndominiums, but the decision to self-build significantly affects both the timeline and the risk profile of the project. Most owner-builders extend their construction timeline by 20 to 40 percent compared to a professional general contractor, primarily because of learning curves, scheduling challenges, and limited access to trade subcontractors.

What owner-builders can realistically handle:

  • General site preparation and clearing (with rented equipment).
  • Interior framing, drywall, painting, and finish carpentry with some experience.
  • Flooring installation.
  • Landscaping and exterior grading.

What almost always requires licensed professionals:

  • Structural engineering and stamped drawings (required for permits in most jurisdictions).
  • Electrical work (licensed electrician required in virtually all U.S. states).
  • Plumbing (licensed plumber required in most states).
  • HVAC installation (typically requires certification and licensing).
  • Steel frame erection (requires a crane and experienced crew; mistakes are dangerous and expensive).

Decision rule: If you have construction experience and can commit full-time to the project, acting as your own general contractor while hiring licensed subcontractors is a reasonable middle path. If you have no construction background and are managing the project part-time, hiring an experienced GC will almost certainly save you money and time in the long run, even after accounting for the GC’s markup.

How Much Longer Does a Custom Barndominium Take Compared to a Standard Kit Design

A custom barndominium typically takes 4 to 8 months longer than a kit-based design, and in complex cases, the gap can be even wider. The difference comes from design time, engineering, manufacturing lead time, and on-site fabrication.

Kit-based barndominium timeline advantages:

  • Standard dimensions mean pre-engineered drawings are often available, reducing design time.
  • Components are pre-cut and pre-drilled at the factory, reducing on-site labor.
  • Pricing is predictable, which speeds up financing approval.
  • Some kit suppliers offer design-build services that bundle the shell and erection into a single contract.

Custom barndominium timeline realities:

  • Architectural design for a fully custom structure takes 6 to 12 weeks.
  • Custom steel fabrication adds 10 to 20 weeks of manufacturing lead time.
  • On-site fitting and adjustment of custom components takes longer than assembling a kit.
  • Unique design elements (curved rooflines, mixed materials, non-standard window placements) require additional engineering review.

A family I spoke with during research for this guide ordered a fully custom 3,200-square-foot barndominium with a detached workshop in central Texas. Their project ran from initial design consultation to move-in in 22 months — well within the expected range for a custom build of that size, but significantly longer than the 10-month timeline they had initially hoped for.

What Are Common Mistakes People Make When Planning a Barndominium Project

The most costly mistakes in barndominium construction happen before the first shovel hits the ground. Poor planning in the early stages creates delays, budget overruns, and sometimes projects that cannot be completed as designed.

The most common planning mistakes:

  • Skipping a soil test: Soil conditions determine foundation type and cost. Expansive clay soils, common in Texas and Oklahoma, can require engineered piers instead of a standard slab, adding cost and time.
  • Underestimating interior finish costs: Many first-time builders budget heavily for the steel shell and run short of funds when it comes to interior finishing. The shell is often 30 to 40 percent of the total budget; interior work is the rest.
  • Not verifying financing before starting design: Construction loans for barndominiums are available but not universal. Some lenders will not finance non-traditional structures. Starting the design process without confirmed financing is a common and expensive mistake.
  • Choosing a contractor without barndominium experience: General contractors who primarily build stick-frame homes may underestimate the complexity of steel frame construction, leading to cost overruns and timeline extensions.
  • Ignoring utility access costs: Running electricity, water, and sewer to a rural property can cost $10,000 to $50,000 or more depending on distance from existing infrastructure.
  • Making changes during construction: Every change order after construction begins costs more than making the same decision during the design phase. Finalize your floor plan, window placements, and electrical layout before breaking ground.

Are Barndominiums Good for Families or Better for Single People and Couples

Barndominiums are genuinely well-suited to families, not just couples or individuals. The open floor plan and flexible square footage make them adaptable to a wide range of household sizes and lifestyles.

Why barndominiums work well for families:

  • Large, open common areas are easy to configure for family living.
  • The workshop or garage bay is popular with families who need space for vehicles, recreational equipment, or home businesses.
  • Single-story designs eliminate stair safety concerns for young children and aging relatives.
  • Rural settings often mean larger lots, giving children more outdoor space.

Considerations for families specifically:

  • Insulation quality matters more with children in the home. Metal buildings can be loud during rain or hail without adequate insulation and interior wall mass.
  • School district quality should be researched carefully when building in rural areas.
  • Emergency services response times in rural areas are longer than in suburban settings, which is a practical consideration for families with young children or elderly members.

Who barndominiums may not suit:

  • Buyers who need traditional mortgage financing and cannot access a construction loan or portfolio lender.
  • Those in HOA-governed communities where metal structures are prohibited.
  • Buyers who prefer a conventional neighborhood setting with nearby amenities.

Are There Any Shortcuts to Reduce Overall Construction Time

There are legitimate ways to compress the barndominium construction timeline without cutting corners on quality. The most effective strategies focus on eliminating idle time between phases rather than rushing individual tasks.

Proven time-saving strategies:

  • Order your steel kit early: Place your steel building order as soon as your design is finalized, even if permits are still pending. Manufacturing lead time runs 8 to 20 weeks, and your kit can arrive ready to erect the moment your permit is approved.
  • Use a design-build contractor: A single firm that handles design, engineering, permitting, and construction eliminates the handoff delays between separate professionals.
  • Pre-select all finish materials before construction begins: Flooring, cabinetry, fixtures, and appliances with long lead times should be ordered during the framing phase, not after drywall is complete.
  • Schedule subcontractors in advance: Book your electrician, plumber, and HVAC contractor before framing is complete so they are ready to begin rough-in immediately after the shell is enclosed.
  • Avoid non-standard dimensions: Sticking to standard door, window, and ceiling heights reduces fabrication time and keeps material costs predictable.

What does not actually save time:

  • Starting construction before permits are approved. Stop-work orders cost more time than they save.
  • Skipping inspections or trying to rush inspectors. Inspectors set their own schedules, and failed inspections require re-inspection appointments that add days or weeks.

FAQ

How long does it take to build a barndominium from start to finish?
The full project timeline, from initial design through move-in, typically runs 9 to 18 months. Active construction (breaking ground to certificate of occupancy) usually takes 6 to 12 months for a mid-size barndominium.

Is a barndominium faster to build than a traditional house?
Generally yes, primarily because the steel shell erects faster than wood framing. However, interior finishing takes roughly the same amount of time as a conventional home, so the overall savings are often 1 to 3 months rather than the dramatic difference some sources suggest.

What is the fastest a barndominium can be built?
A small, simple kit-based barndominium in a county with streamlined permitting, mild weather, and an experienced crew could theoretically be completed in 4 to 6 months from breaking ground. This is the exception, not the norm.

Do I need an architect to design a barndominium?
Most counties require stamped engineering drawings for a steel-frame structure, which means you need at minimum a licensed structural engineer. An architect can help with the layout and aesthetics, but is not always legally required.

Can a barndominium be financed with a conventional mortgage?
Some lenders will finance a completed barndominium with a conventional mortgage, but construction financing is typically done through a construction-to-permanent loan or a portfolio lender. Fannie Mae and Freddie Mac guidelines have historically been restrictive for non-traditional structures, though lender policies vary.

How long does a barndominium last compared to a traditional home?
A well-built steel-frame barndominium can last 50 years or more with proper maintenance. Metal roofing typically lasts 40 to 70 years. The structure itself is highly resistant to termites, rot, and fire, which are common causes of deterioration in wood-frame homes.

What size barndominium can I build on one acre?
One acre (43,560 square feet) provides ample space for most barndominium designs, including a main structure, septic system, well, and driveway. Local setback requirements determine how close to property lines you can build, typically 15 to 50 feet depending on the county.

Is it cheaper to build a barndominium or buy an existing home?
In most U.S. markets as of 2026, building a turnkey barndominium costs $100 to $150 per square foot, which can be competitive with existing home prices in rural areas but is often more expensive than purchasing a comparable existing home in suburban markets.

How does the barndominium construction timeline change if I am acting as my own general contractor?
Owner-builders typically extend the construction timeline by 20 to 40 percent compared to an experienced GC, primarily due to learning curves and subcontractor scheduling challenges.

What is the biggest single factor in how long it takes to build a barndominium?
Permitting and contractor availability are the two most variable factors. In some counties, permitting alone takes 4 to 6 months. In markets with high construction demand, contractor scheduling can add another 3 to 6 months before work even begins.

Conclusion

Understanding how long it takes to build a barndominium requires looking at the full project arc, not just the framing and finishing phases. The realistic answer for most builders is 9 to 18 months from first design meeting to move-in day, with active construction running 6 to 12 months of that total.

The builders who finish on time and on budget share a few common habits: they confirm zoning and financing before committing to a design, they order their steel kit early to avoid manufacturing lead time delays, they hire contractors with specific barndominium experience, and they finalize every specification before breaking ground.

Actionable next steps for 2026:

  1. Contact your county building department and confirm that your property is zoned for a barndominium before purchasing land or beginning design.
  2. Speak with at least three lenders about construction-to-permanent loan options for non-traditional structures.
  3. Request quotes from at least two steel building kit suppliers and ask about current manufacturing lead times.
  4. Interview general contractors who have completed at least three barndominium projects and ask to see references and photos.
  5. Commission a soil test before finalizing your foundation design.
  6. Build a 15 percent time buffer and a 15 percent cost contingency into your project plan before you commit to any move-in date.

A barndominium is one of the more rewarding building projects a homeowner can undertake, but it rewards careful planning far more than it rewards speed. Take the time to do the early work thoroughly, and the construction phase will run considerably smoother.

References

Hank Bridger Avatar

Hank Bridger

Author Metal Building Expert | Founder of Durapedia | Author of Barndominium Reality Check | 10+ Years Installing Residential, Agricultural & Commercial Steel Structures

Hank Bridger is the founder and lead author of Durapedia. A metal building installer since 2015, Hank has over a decade of hands-on experience erecting residential, agricultural, commercial, and industrial steel structures. Hank is passionate about sharing practical, real-world advice to help readers make informed decisions and avoid costly mistakes with metal buildings.

Areas of Expertise: Author of the popular book Barndominium Reality Check (available on Amazon).
