How to Choose the Right Metal Building: A Complete Buyer's Guide

Last updated: May 18, 2026


Quick Answer

Choosing the right metal building comes down to five core decisions: building type (clear-span, modular, or Quonset), intended use, local building codes, site conditions, and budget. Match the structural system to your load requirements and climate first, then compare manufacturers on warranty, steel gauge, and engineering certifications. Getting these fundamentals right before you request a quote will save thousands of dollars and prevent costly redesigns.


Key Takeaways

  • Define your use case first. A farm storage shed has entirely different structural requirements than a commercial warehouse or aircraft hangar.
  • Clear-span rigid-frame buildings offer the most usable interior space and suit most commercial and industrial applications.
  • Local building codes and wind/snow load ratings are non-negotiable — verify them before finalizing any design.
  • Steel gauge matters. Thinner gauge (higher number) costs less upfront but may compromise long-term durability in harsh climates.
  • Foundation type (slab, pier, or stem wall) must be engineered to match the building’s dead load, live load, and local frost depth.
  • Get at least three quotes from certified manufacturers and compare them line by line, not just by total price.
  • Delivery and erection costs can add 20–40% to the base building price and are frequently underestimated by first-time buyers.
  • Insulation and ventilation are often afterthoughts but directly affect energy costs and building longevity.
  • A reputable manufacturer will provide stamped engineering drawings and a minimum 25-year paint warranty on Galvalume or Kynar-coated panels.

Why Metal Buildings Have Become the Default Choice for So Many Projects

Metal buildings now account for more than half of all low-rise non-residential construction in the United States, according to the Metal Building Manufacturers Association (MBMA). That dominance didn’t happen by accident. Steel structures go up faster, cost less per square foot than wood-frame or masonry alternatives for most span widths, and carry predictable maintenance profiles over a 40–60 year lifespan.

Still, “metal building” is a broad category. A 12×20 backyard workshop and a 200×400 distribution center are both metal buildings, but they share almost nothing in terms of design, engineering, or procurement process. Knowing how to choose the right metal building for your specific project is what separates buyers who are satisfied five years later from those who are dealing with leaks, code violations, or structures that simply don’t fit their workflow.

I’ve spoken with dozens of contractors, agricultural operators, and small business owners who rushed the selection process and paid for it — sometimes literally, with expensive retrofits. This guide is built around the questions they wish they’d asked earlier.


What Are the Main Types of Metal Buildings?

The three primary structural systems each have a distinct use case, cost profile, and limitation.

1. Clear-Span Rigid Frame (most common)
A rigid-frame building uses welded steel I-beams to create a self-supporting arch or straight-wall structure with no interior columns. Spans of 30 to 300 feet are achievable. This system works best for warehouses, retail spaces, aircraft hangars, and any application where unobstructed floor space matters.

2. Modular / Multi-Span Frame
Interior columns are added to support wider structures at lower cost. The trade-off is that columns interrupt floor space. Choose this system if your use case can tolerate columns (cold storage, manufacturing with fixed equipment layouts) and your span exceeds 150 feet.

3. Quonset / Arch Buildings
A curved corrugated steel shell with no separate frame. These are the least expensive per square foot and go up quickly, but wall space is limited by the curve, and interior height drops sharply toward the edges. Best for grain storage, equipment shelters, and temporary structures.

Building Type Best For Typical Span Relative Cost
Clear-Span Rigid Frame Warehouses, hangars, retail 30–300 ft Medium–High
Multi-Span Modular Large industrial, cold storage 100–500+ ft Medium
Quonset / Arch Storage, agriculture, temporary 20–150 ft Low

Decision rule: If unobstructed interior space is a priority, choose clear-span rigid frame. If budget is the primary constraint and columns are acceptable, go modular. If you need fast, low-cost agricultural storage, Quonset works well.


How to Choose the Right Metal Building for Your Specific Use

The right building starts with a precise use-case definition. Vague requirements produce vague (and often wrong) quotes.

Ask yourself these questions before contacting a single manufacturer:

  • What will be stored or manufactured inside? (Weight, height, and access requirements vary enormously.)
  • How many vehicles, forklifts, or large equipment pieces need to enter? (This determines door size and clearance height.)
  • Will the building be climate-controlled? (Insulation requirements change the entire wall and roof assembly.)
  • Do you need mezzanine levels, cranes, or overhead equipment? (These add significant load requirements.)
  • What is the expected lifespan of the project? (A 5-year temporary structure has different specs than a 40-year permanent facility.)

Common use cases and their key requirements:

  • Agricultural storage: High clear heights (16–20 ft), wide sliding or bi-fold doors, minimal HVAC, vapor barrier at slab.
  • Commercial warehouse/distribution: Dock doors, fire suppression system rough-in, high bay lighting layout, potential crane rail.
  • Retail or office: Insulated wall panels, windows, HVAC, aesthetic exterior finish options.
  • Residential garage or workshop: Local residential zoning compliance, finished interior options, smaller footprint.
  • Aircraft hangar: FAA clearance requirements, bi-fold or hydraulic doors, specific floor loading.

A common mistake is ordering a building sized for current needs without accounting for growth. Adding 20% to your planned square footage at the design stage is almost always cheaper than adding a lean-to or separate structure later.


What Building Codes and Load Requirements Apply to Your Site?

Every metal building must meet the building codes and environmental load requirements of its specific location. This is not optional, and it’s one of the most frequently overlooked steps by first-time buyers.

Key load categories to verify with your local building department:

  • Snow load (ground and roof): Measured in pounds per square foot (psf). Requirements vary from near zero in southern states to 100+ psf in mountain regions.
  • Wind speed: Expressed in miles per hour (mph) and tied to ASCE 7 risk categories. Coastal and tornado-prone areas have significantly higher requirements.
  • Seismic zone: Critical in California, the Pacific Northwest, and parts of the central U.S.
  • Live load and dead load: The combined weight of occupants, equipment, roof-mounted HVAC, and the structure itself.

🏗️ Important: A reputable metal building manufacturer will ask for your zip code and intended use category before quoting. If they don’t ask, that’s a red flag.

Most manufacturers design to International Building Code (IBC) standards, but local amendments are common. Always request a letter of certification or stamped engineering drawings from a licensed Professional Engineer (PE) registered in your state. This documentation is typically required for a building permit.

Edge case: Agricultural buildings in rural areas often fall under less stringent agricultural exemptions in many states, which can reduce costs. However, if the building will ever be used commercially or have employees inside, the agricultural exemption may not apply. Confirm this with your county building department before assuming the exemption covers your project.


How Do You Evaluate Metal Building Manufacturers and Suppliers?

Not all metal building companies are equal. The industry has a wide range of quality levels, and price alone is a poor differentiator.

Criteria for evaluating manufacturers:

  1. MBMA membership: The Metal Building Manufacturers Association sets quality and engineering standards. Member companies are held to documented manufacturing practices.
  2. IAS or similar accreditation: Independent third-party audits of manufacturing facilities confirm quality control processes.
  3. PE-stamped drawings: Engineering drawings stamped by a licensed engineer in your state are required for most permits and confirm the structure is designed to code.
  4. Warranty terms: Look for a minimum 25-year paint warranty on Galvalume steel and a 40-year structural warranty on the primary frame. Read the exclusions carefully.
  5. References and completed projects: Ask for references from buyers with similar use cases in similar climates. A company that builds well in Arizona may not have experience with heavy snow loads in Minnesota.
  6. Lead times: As of 2026, lead times for engineered metal buildings typically range from 8 to 20 weeks depending on size and customization. Factor this into your project schedule.

Questions to ask every manufacturer:

  • What steel gauge are the secondary framing members (purlins, girts)?
  • Is the primary frame hot-rolled or cold-formed steel?
  • What is the base steel yield strength (typically 50 ksi for primary frames)?
  • Who is responsible for the foundation design?
  • What does the quote include and exclude (anchor bolts, trim, insulation, erection)?

What Does a Metal Building Actually Cost?

Metal building pricing is notoriously difficult to generalize because it depends on size, specification, location, and market steel prices. That said, here are reasonable 2026 estimates based on industry data and manufacturer published ranges.

Typical cost ranges (building package only, not including foundation or erection):

Building Size Estimated Package Cost
30×40 (1,200 sq ft) $15,000–$28,000
50×100 (5,000 sq ft) $45,000–$85,000
100×200 (20,000 sq ft) $180,000–$320,000

Note: These are estimates based on publicly available manufacturer pricing ranges as of early 2026. Actual costs vary with steel market conditions, specification level, and regional factors.

Cost factors that move the number significantly:

  • Insulation: A fully insulated building can add $2–$5 per square foot to the package cost.
  • Door and window packages: Large bi-fold or hydraulic doors for hangars can add $20,000–$80,000 alone.
  • Interior liner panels: Finished interior walls add cost but improve aesthetics and insulation performance.
  • Foundation: A concrete slab for a 5,000 sq ft building typically runs $20,000–$50,000 depending on thickness, reinforcement, and local labor rates.
  • Erection labor: Typically $3–$8 per square foot for professional erection crews.

💡 A common mistake: Buyers compare quotes without confirming that each quote covers the same scope. One manufacturer’s “complete package” may include insulation and trim; another’s may not. Always request an itemized quote.


How to Choose the Right Metal Building Size and Layout

Getting the size right is more than measuring your current equipment footprint. A well-sized building accounts for workflow, future expansion, code-required clearances, and site constraints.

Step-by-step sizing process:

  1. List every function the building must support and the square footage each requires.
  2. Add circulation space — aisles, staging areas, and emergency egress paths (typically 20–30% of functional area).
  3. Determine clear height requirements based on your tallest equipment, vehicle, or stored material, plus 2–3 feet of clearance.
  4. Check setback requirements with your local zoning office. Most jurisdictions require minimum distances from property lines, roads, and other structures.
  5. Orient the building to take advantage of natural light, prevailing wind for ventilation, and site drainage patterns.
  6. Add 15–20% for growth unless the site physically cannot accommodate it.

Bay spacing (the distance between rigid frames) affects both cost and flexibility. Standard bay spacings of 20–25 feet work for most applications. Wider bays (30–40 ft) cost more per bay but reduce the number of interior columns in multi-span buildings and make future modifications easier.

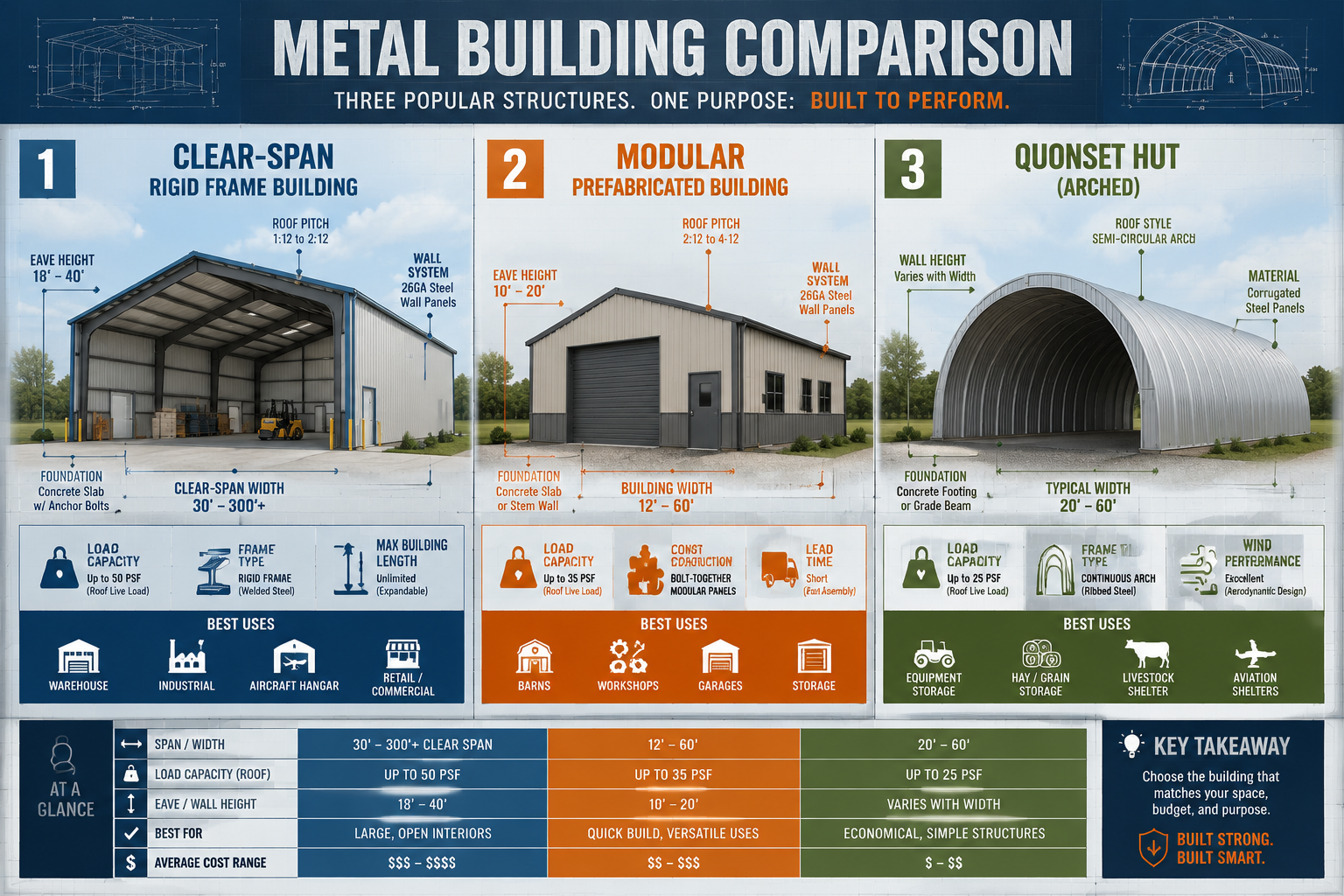

Detailed () educational infographic-style illustration showing a side-by-side comparison of three metal building types:


What Are the Most Common Mistakes When Buying a Metal Building?

Even experienced buyers make these errors. Knowing them in advance is the fastest way to avoid them.

Mistake 1: Choosing based on price alone
The lowest quote almost always reflects lower steel gauge, thinner coatings, or missing components. A building that costs 15% less upfront but requires re-roofing in 12 years instead of 35 is not a bargain.

Mistake 2: Skipping the site evaluation
Soil bearing capacity, drainage patterns, and utility locations all affect foundation design and site prep costs. A geotechnical report (soil test) costs $500–$2,000 and can prevent foundation failures that cost tens of thousands to correct.

Mistake 3: Underestimating permitting time
In many jurisdictions, commercial building permits take 4–12 weeks to process after submission. Agricultural permits are often faster. Build permitting time into your project schedule before ordering the building.

Mistake 4: Ignoring insulation until after the quote
Retrofitting insulation into an existing metal building is significantly more expensive than installing it during construction. Decide on your thermal envelope requirements before you finalize the design.

Mistake 5: Not confirming who erects the building
Some manufacturers sell erection services; others sell building-only packages and expect you to hire a local crew. Erection quality directly affects the building’s performance and warranty validity. Confirm this in writing.


FAQ: How to Choose the Right Metal Building

Q: How long does a metal building last?
A properly engineered and maintained metal building with Galvalume steel panels and a quality paint system has a service life of 40–60 years. The primary steel frame, if protected from corrosion, can last considerably longer.

Q: Do I need a building permit for a metal building?
In almost all cases, yes. Permanent structures require a building permit regardless of material. Some rural agricultural exemptions exist, but they are jurisdiction-specific and do not apply to commercial or employee-occupied buildings.

Q: What is the best foundation for a metal building?
A reinforced concrete slab is the most common and practical foundation for most metal buildings. Pier foundations work for lighter structures in areas with deep frost lines. The right choice depends on soil conditions, building weight, and local frost depth — a PE should specify the foundation.

Q: Can I expand a metal building after it’s built?
Yes, most rigid-frame metal buildings are designed to accept future expansion in the length direction (adding bays). Expanding in width requires a new frame design. Tell your manufacturer about expansion plans upfront so the endwall framing is designed accordingly.

Q: What gauge steel is best for a metal building?
For primary frames, 50 ksi hot-rolled steel is standard. For roof and wall panels, 26-gauge is common for residential and light commercial; 24-gauge is preferred for commercial and industrial applications where dent resistance and longevity matter more.

Q: How do I compare metal building quotes accurately?
Request itemized quotes that specify steel gauge, panel profile, coating system, insulation R-value, door and window packages, anchor bolt package, and what is excluded. Compare line by line, not just total price.

Q: Are metal buildings energy efficient?
They can be, but the building envelope must be properly designed. Metal conducts heat readily, so thermal breaks, high-R insulation systems, and reflective coatings are important. An uninsulated metal building is not energy efficient.

Q: What is a Galvalume coating and why does it matter?
Galvalume is a zinc-aluminum alloy coating applied to steel panels that provides superior corrosion resistance compared to standard galvanized steel. It’s the industry standard for roof panels and significantly extends service life in humid or coastal environments.

Q: How far in advance should I order a metal building?
For most engineered building packages, plan for 8–20 weeks from order to delivery as of 2026. Add 4–12 weeks for permitting and 2–6 weeks for site prep. Starting the process 9–12 months before your target occupancy date is a reasonable planning horizon for most commercial projects.

Q: Can metal buildings be used for residential purposes?
Yes. Steel frame residential construction (often called “barndominium” or steel-frame homes) is legal in most jurisdictions, though local residential codes and lender requirements vary. Confirm zoning and financing options before committing to a residential metal building project.


Conclusion: Your Next Steps for Choosing the Right Metal Building

The process of choosing the right metal building is more structured than most buyers expect, but it’s also more manageable once you break it into clear stages. Here’s a practical sequence to follow:

  1. Define your use case in writing — function, size, clear height, door requirements, climate control needs, and expected lifespan.
  2. Contact your local building department to confirm zoning, setbacks, and load requirements (snow, wind, seismic) before you talk to a single manufacturer.
  3. Request itemized quotes from at least three MBMA-member manufacturers, using the same specification sheet so comparisons are apples-to-apples.
  4. Commission a soil test if you don’t already have geotechnical data for your site.
  5. Verify PE-stamped drawings are included in the package and that the engineer is licensed in your state.
  6. Build a realistic timeline that includes permitting, site prep, delivery, and erection — not just the manufacturing lead time.
  7. Read the warranty carefully, paying particular attention to what voids coverage (improper erection, unapproved modifications, failure to maintain drainage).

A metal building is a long-term asset. The decisions you make in the first few weeks of the process — about structural system, steel specification, and manufacturer quality — will affect the building’s performance for decades. Take the time to get those decisions right, and the rest of the project tends to follow.


References

  • Metal Building Manufacturers Association (MBMA). Metal Building Systems Manual. MBMA, 2021. https://www.mbma.com
  • American Iron and Steel Institute (AISI). North American Specification for the Design of Cold-Formed Steel Structural Members. AISI, 2016. https://www.steel.org
  • American Society of Civil Engineers. ASCE 7-22: Minimum Design Loads and Associated Criteria for Buildings and Other Structures. ASCE, 2022. https://www.asce.org
  • International Code Council. International Building Code (IBC) 2021. ICC, 2020. https://www.iccsafe.org

Hank Bridger Avatar

Hank Bridger

Author Metal Building Installer Since 2015, Book Author

Hank Bridger is the founder and lead author of Durapedia. A metal building installer since 2015, Hank has over a decade of hands-on experience erecting residential, agricultural, commercial, and industrial steel structures. Hank is passionate about sharing practical, real-world advice to help readers make informed decisions and avoid costly mistakes with metal buildings.

Areas of Expertise: Author of the popular book Barndominium Reality Check (available on Amazon).

Learn more about my book - Barndominium Reality Check

Learn more about the author

Fact Checked & Editorial Guidelines
Reviewed by: Subject Matter Experts
