How Metal Buildings Are Constructed: A Complete Step-by-Step Guide

Last updated: May 18, 2026


Quick Answer: Metal buildings are constructed by first engineering and fabricating structural steel components off-site, then erecting a foundation, assembling a rigid steel frame, and attaching wall and roof panels on-site. The process is faster than traditional construction because most parts arrive pre-engineered and ready to bolt together. A standard commercial metal building can go from an empty lot to a weather-tight shell in days to weeks, depending on size.


Key Takeaways

  • Metal buildings use a pre-engineered system: structural members are designed, cut, and drilled at a factory before delivery.
  • The construction sequence follows a fixed order: site prep → foundation → anchor bolts → primary steel frame → secondary framing → roofing → wall panels → trim and accessories.
  • Rigid frame systems are the most common structural approach for commercial and agricultural metal buildings.
  • Steel building kits from manufacturers typically include all primary and secondary steel, fasteners, and cladding panels.
  • Metal buildings cost less per square foot to erect than wood-frame or concrete structures, largely because of reduced on-site labor.
  • Common mistakes include incorrect anchor bolt placement, skipping proper grounding, and underestimating local wind and snow load requirements.
  • Building permits and engineered drawings are required in virtually all U.S. jurisdictions before construction begins.
  • Insulation, interior finishes, and mechanical systems are added after the shell is complete and are separate from the base building package.

What Is a Pre-Engineered Metal Building?

A pre-engineered metal building (PEMB) is a structural system where all steel components are designed by a manufacturer’s engineering team, fabricated in a controlled factory environment, and shipped to the job site ready for assembly. The key distinction from conventional construction is that the engineering and fabrication happen before the building is ever touched on-site.

Why this matters for buyers and builders: Because the design is standardized and computer-optimized, pre-engineered systems use steel more efficiently than field-fabricated structures. Less material waste and faster assembly translate directly into lower project costs.

Key components in a typical PEMB package

Component Description
Primary structural frames Welded steel columns and rafters forming the main skeleton
Secondary framing Purlins, girts, and eave struts that support cladding
Roof and wall panels Roll-formed steel sheets, usually 26- or 29-gauge
Fasteners and trim Bolts, screws, flashing, and ridge caps
Anchor bolts Embedded in the foundation to connect the frame

💡 Choose a PEMB if you need a large clear-span space (warehouses, workshops, airplane hangars) or if construction speed is a priority. Conventional steel fabrication makes more sense for highly custom architectural projects.


How Metal Buildings Are Constructed: The Full Process from Start to Finish

Understanding how metal buildings are constructed means following a logical sequence. Skipping or rushing any phase creates problems that are expensive to fix later. Here is the standard construction workflow used by professional erectors in 2026.

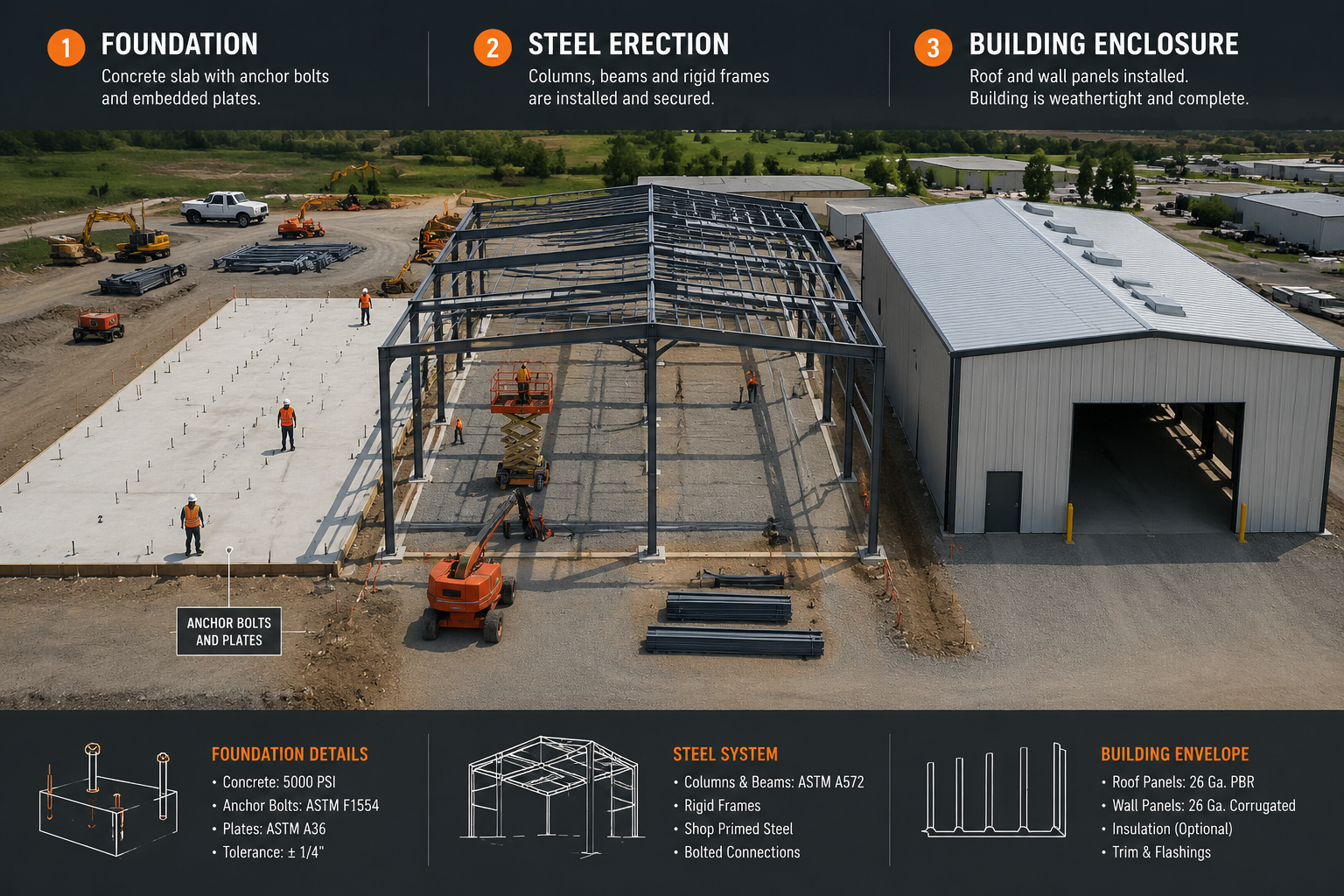

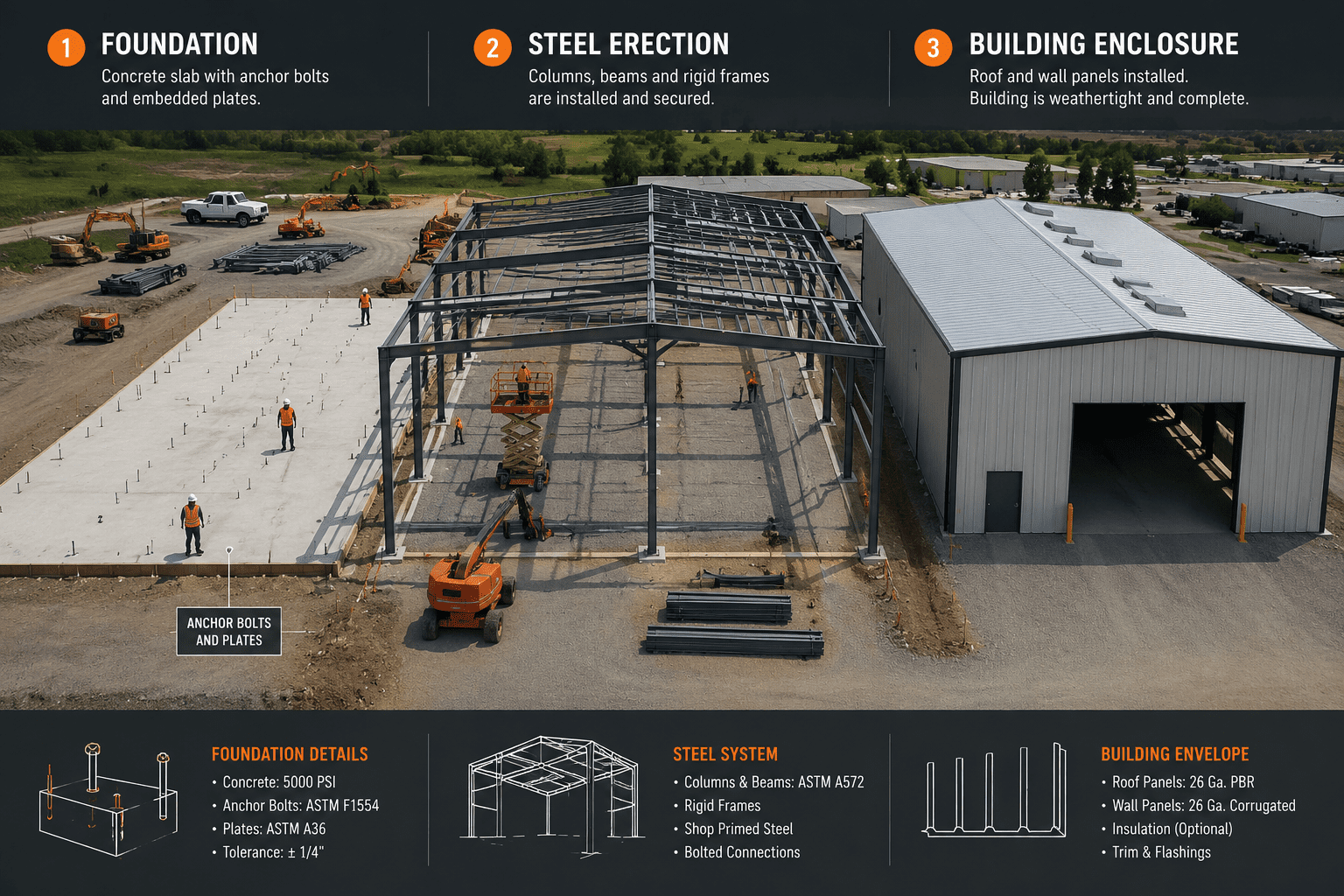

Detailed () technical illustration and real-photo composite showing the sequential phases of metal building construction:

Phase 1: Site Preparation and Permits

Before any steel is ordered, the site must be evaluated and permits secured.

  • Soil testing determines bearing capacity, which directly affects foundation design.
  • Grading and drainage planning prevents water from pooling under or around the slab.
  • Local building permits require stamped engineering drawings. Most manufacturers provide these as part of the package, but the buyer must submit them to the local authority having jurisdiction (AHJ).
  • Utility locates must be completed before any excavation begins.

Common mistake: Ordering the building kit before permits are approved. If the AHJ requires design changes (different wind load, fire separation, etc.), you may need to modify or reorder components.

Phase 2: Foundation Design and Pouring

The foundation is the most critical part of the entire project. Metal buildings almost always use a concrete slab-on-grade with embedded anchor bolts, though pier-and-grade-beam foundations are used in cold climates with deep frost lines.

Steps in foundation construction:

  1. Excavate and compact the sub-base.
  2. Install gravel base (typically 4–6 inches of compacted crushed stone).
  3. Place vapor barrier if the slab will be enclosed.
  4. Set anchor bolt templates (supplied by the building manufacturer) at precise column locations.
  5. Pour concrete to the specified thickness and strength (commonly 4–6 inches at 3,000–4,000 PSI for light commercial use).
  6. Allow concrete to cure — minimum 7 days before frame erection, ideally 28 days for full design strength.

Edge case: In seismic zones, foundations require additional rebar, deeper footings, and hold-down hardware. Always confirm seismic design category with the local building department.

Phase 3: Receiving and Inspecting the Steel Package

When the building kit arrives by flatbed truck, the erection crew must:

  • Verify the bill of lading against the manufacturer’s packing list.
  • Inspect for shipping damage, especially to welded connections and pre-punched holes.
  • Organize components by erection sequence — primary frames first, secondary framing next, panels last.

Missing or damaged parts must be reported to the manufacturer immediately. Most manufacturers have a standard claim window (often 30 days from delivery).

Phase 4: Erecting the Primary Steel Frame

This is the most visually dramatic phase of how metal buildings are constructed. A crane or telehandler lifts the welded rigid frames into position.

Typical erection sequence for a clear-span rigid frame building:

  1. Set end-wall columns at both ends of the building first.
  2. Plumb and brace the first interior frame before releasing the crane — never leave a frame standing without temporary bracing.
  3. Erect interior frames one bay at a time, moving from one end to the other.
  4. Install eave struts connecting frame tops along the building length.
  5. Check plumb, level, and square at each frame before proceeding.

⚠️ Safety note: OSHA’s steel erection standard (29 CFR 1926 Subpart R) requires specific fall protection and connector qualifications. Never allow unqualified workers to connect structural steel at height.

Phase 5: Installing Secondary Framing

Secondary framing members — purlins (roof) and girts (walls) — span between primary frames and provide attachment points for the cladding panels.

  • Purlins and girts are typically cold-formed Z- or C-shaped steel sections.
  • They are bolted to clips welded onto the primary frames.
  • Bridging and bracing rods are installed diagonally between purlins to prevent lateral buckling.
  • Openings for doors, windows, and louvers are framed out at this stage using jambs and headers from the building package.

Phase 6: Roofing

Roof installation begins before wall panels because a weather-tight roof protects the interior from rain during the rest of construction.

Standard standing-seam or through-fastened roof installation:

  1. Install insulation (batt or blanket type) over purlins if a thermal envelope is required.
  2. Start roof panels at one eave, running panels from eave to ridge.
  3. Lap or mechanically seam panels per the manufacturer’s instructions.
  4. Install ridge cap, eave trim, and any penetration flashings.
  5. Install gutters and downspouts if specified.

Standing-seam vs. through-fastened panels:

  • Standing-seam panels clip to purlins without exposed fasteners — better long-term weather performance, higher cost.
  • Through-fastened panels use exposed screws — faster and cheaper to install, but screws require periodic inspection for washer degradation.

Phase 7: Wall Panel Installation

Wall panels attach to the girts and are installed similarly to roof panels but vertically or horizontally depending on the panel profile.

  • Insulation is typically installed between the girts and panels using a thermal block system or by sandwiching batt insulation.
  • Wainscot panels (a different color or profile at the lower wall section) are a common aesthetic and durability upgrade.
  • Trim pieces — corner trim, base trim, window and door trim — complete the weather seal and give the building a finished appearance.

Phase 8: Doors, Windows, and Accessories

After the shell is closed in:

  • Walk doors and overhead doors are set into pre-framed openings.
  • Skylights and translucent panels are installed in the roof or walls for natural light.
  • Ventilation louvers or ridge vents are added for airflow.
  • Gutters, downspouts, and splash blocks complete the drainage system.

Phase 9: Interior Buildout and Mechanical Systems

The base building package does not include interior finishes, electrical, plumbing, or HVAC. These are contracted separately and follow standard commercial construction practices once the shell is complete.


What Are the Structural Systems Used in Metal Building Construction?

Metal buildings use one of three primary structural approaches, and the choice affects cost, span capability, and appearance.

Structural System Max Clear Span Best For
Rigid frame (tapered) Up to 300 ft Warehouses, retail, churches
Modular (multi-span) Virtually unlimited Large distribution centers
Lean-to Up to 60 ft Additions, covered walkways

Rigid frame systems are the industry standard for single-story commercial metal buildings. The tapered column and rafter profile is not just aesthetic — it places more steel where bending stress is highest (at the knee and ridge) and less where stress is lower, which is efficient use of material.


How Long Does It Take to Construct a Metal Building?

Construction timelines vary by building size, site conditions, crew experience, and permit processing speed. Here are realistic estimates for common project types in 2026:

  • Small agricultural building (40×60 ft): 2–5 days for the shell with an experienced 4-person crew.
  • Mid-size commercial building (80×120 ft): 2–4 weeks for shell erection.
  • Large industrial facility (200×400 ft): 6–12 weeks for structural erection.

Permit processing is often the longest variable — it can range from 2 weeks in rural counties to 3–4 months in dense urban jurisdictions.

Key insight: The actual steel erection is rarely the bottleneck. Site prep, foundation curing, and permit approval almost always take longer than putting the steel up.


What Are the Most Common Mistakes in Metal Building Construction?

Even experienced contractors make avoidable errors. Here are the mistakes that cause the most costly rework:

  1. Anchor bolt misplacement. If anchor bolts are set even a fraction of an inch off the template, column base plates won’t align. Always use the manufacturer’s anchor bolt template and verify with a survey instrument before pouring.
  2. Ignoring local load requirements. Metal building manufacturers design to specified wind, snow, and seismic loads. Ordering a building without confirming local code requirements can result in an under-designed structure that fails inspection.
  3. Skipping temporary bracing. Frames are not stable until the entire bay is connected and braced. Unbraced frames have collapsed during erection due to wind gusts.
  4. Improper panel lapping. Roof and wall panels have a designated overlap direction relative to prevailing wind and rain. Reversing the lap direction creates leak paths.
  5. Not accounting for thermal movement. Steel expands and contracts with temperature. Fastener patterns and panel end laps must accommodate this movement, or panels will buckle or leak.

How Much Does It Cost to Construct a Metal Building?

Metal building costs vary widely based on size, design complexity, location, and finish level. The following ranges are general estimates for the U.S. market in 2026 and should be verified with local contractors and suppliers.

  • Building kit only (materials): Roughly $10–$25 per square foot for a standard commercial package, depending on size and specifications.
  • Foundation: $4–$8 per square foot for a basic slab-on-grade.
  • Erection labor: $3–$8 per square foot depending on building complexity and regional labor rates.
  • Total shell (kit + foundation + erection): Commonly estimated in the $20–$45 per square foot range for a basic enclosed shell.
  • Fully finished interior (HVAC, electrical, plumbing, insulation, interior walls): Can add $30–$80+ per square foot depending on use type.

Choose a metal building if you need a large enclosed space at a lower cost per square foot than wood-frame or tilt-up concrete construction, and if the industrial aesthetic is acceptable or can be finished over.


FAQ: How Metal Buildings Are Constructed

Q: Do metal buildings require a concrete foundation?
Yes, in nearly all cases. Concrete slab-on-grade with embedded anchor bolts is the standard. The foundation must be designed by a licensed engineer to match the building’s column reactions and local soil conditions.

Q: Can I erect a metal building myself?
Small agricultural buildings (under 5,000 sq ft) are sometimes owner-erected using the manufacturer’s erection manual. However, most jurisdictions require a licensed contractor for permitted commercial structures, and structural steel erection carries serious safety risks without proper training and equipment.

Q: How are metal buildings insulated?
The most common method is fiberglass batt insulation (vinyl-faced) installed between the secondary framing and the panels. More energy-efficient options include spray foam applied to the interior of the metal panels, or engineered thermal block systems that break the conductive path between the steel and the exterior skin.

Q: What is the lifespan of a metal building?
A properly designed, erected, and maintained metal building can last 50 years or more. The primary durability factors are the quality of the steel coating (Galvalume or painted), the quality of sealants and fasteners, and maintenance of the roof and wall panels.

Q: Are metal buildings resistant to fire?
Steel is non-combustible, which gives metal buildings an advantage over wood-frame construction. However, unprotected structural steel loses strength at high temperatures. Buildings requiring fire-resistance ratings (typically commercial occupancies) need spray-applied fireproofing or intumescent coatings on structural members.

Q: How do metal buildings handle condensation?
Condensation (also called “sweating”) occurs when warm, moist interior air contacts cold steel surfaces. Proper insulation with a continuous vapor barrier on the warm side of the assembly is the standard solution. Without adequate insulation, condensation can cause corrosion and dripping.

Q: Can metal buildings be expanded later?
Yes, and this is one of their key advantages. Most manufacturers design buildings with future expansion in mind. End walls can be removed and new bays added in the same direction, or lean-to additions can be attached to sidewalls.

Q: What permits are required to build a metal building?
A building permit is required in virtually every U.S. jurisdiction. The permit application typically requires stamped structural drawings, a site plan, and sometimes mechanical, electrical, and plumbing plans if the building will be occupied. Some rural counties have minimal requirements for agricultural structures.


Conclusion

The process of how metal buildings are constructed follows a clear, repeatable sequence: engineering and fabrication off-site, then site prep, foundation, primary frame erection, secondary framing, roofing, wall panels, and finish work. Each phase builds directly on the one before it, and errors in early phases (especially anchor bolt placement and foundation curing) are the most expensive to correct.

Actionable next steps if you’re planning a metal building project in 2026:

  1. Confirm local building codes and load requirements (wind, snow, seismic) before contacting any manufacturer.
  2. Get at least three quotes from reputable pre-engineered building manufacturers — compare the included scope carefully, not just the price.
  3. Hire a licensed civil or structural engineer to design your foundation, even if the building manufacturer provides the structural drawings for the steel package.
  4. Verify your erection contractor’s experience with the specific building system you’re purchasing — not all metal building erectors are familiar with all manufacturers’ connection details.
  5. Plan your interior buildout scope before finalizing the shell design — door locations, electrical panel placement, and HVAC penetrations are much easier to accommodate during design than after erection.

Metal building construction is one of the most cost-effective and time-efficient methods available for large enclosed structures. With proper planning, qualified contractors, and attention to the details outlined above, a metal building project can be completed on time, on budget, and built to last for decades.


References


Hank Bridger Avatar

Hank Bridger

Author Metal Building Installer Since 2015, Book Author

Hank Bridger is the founder and lead author of Durapedia. A metal building installer since 2015, Hank has over a decade of hands-on experience erecting residential, agricultural, commercial, and industrial steel structures. Hank is passionate about sharing practical, real-world advice to help readers make informed decisions and avoid costly mistakes with metal buildings.

Areas of Expertise: Author of the popular book Barndominium Reality Check (available on Amazon).

Learn more about my book - Barndominium Reality Check

Learn more about the author

Fact Checked & Editorial Guidelines
Reviewed by: Subject Matter Experts
