How Long It Takes to Build a Metal Building: A Complete Timeline Guide

Last updated: May 18, 2026


Quick Answer

A metal building typically takes 2 to 6 months to complete from the initial design phase to occupancy, though the actual on-site construction often runs just 1 to 8 weeks depending on building size and complexity. Pre-engineered steel buildings are significantly faster to erect than traditional wood-frame or concrete structures because most components arrive pre-cut and pre-drilled from the factory. The total timeline is shaped by permitting, site conditions, foundation work, and the size of the crew.


Key Takeaways

  • Total project timeline: 2 to 6 months from design to move-in, for most residential and commercial metal buildings.
  • On-site erection time: A small metal building (under 3,000 sq ft) can be erected in 1 to 3 weeks; larger structures may take 4 to 8 weeks or more.
  • Permitting is often the longest delay, sometimes adding 4 to 12 weeks depending on the jurisdiction.
  • Foundation work typically adds 1 to 3 weeks and must fully cure before steel erection begins.
  • Pre-engineered steel kits reduce on-site labor time by 30–50% compared to conventional construction (estimate based on industry-reported averages from steel building manufacturers).
  • Weather, crew size, and site access are the three most common causes of schedule overruns.
  • Custom designs take longer to engineer and fabricate than standard kit buildings.
  • Interior finishing (insulation, electrical, plumbing, drywall) can add 4 to 12 weeks after the shell is complete.
  • Planning ahead and securing permits early is the single most effective way to shorten the overall timeline.

What Is the Overall Timeline for Building a Metal Building?

Understanding how long it takes to build a metal building starts with recognizing that the project has several distinct phases, and on-site construction is only one of them. From the first design conversation to the day you unlock the front door, most projects run between 2 and 6 months.

Here is a realistic phase-by-phase breakdown:

Phase Estimated Duration
Design & engineering 1–4 weeks
Permitting 2–12 weeks
Site preparation 1–2 weeks
Foundation (pour + cure) 1–3 weeks
Steel fabrication & delivery 4–10 weeks
Steel erection (shell) 1–8 weeks
Interior finishing 4–12 weeks
Inspections & occupancy 1–2 weeks

Pull quote: “The steel goes up fast. The paperwork takes longer than most people expect.”

The erection phase is where metal buildings earn their reputation for speed. But the phases before and after the steel work can stretch the calendar considerably, especially in jurisdictions with slow permit offices or in regions with harsh weather seasons.


How Does the Design and Engineering Phase Affect the Schedule?

Design and engineering typically take 1 to 4 weeks, and this phase directly controls how quickly fabrication can begin. No steel gets cut until the engineering drawings are finalized and stamped.

What happens during this phase:

  • The building’s dimensions, load requirements (snow, wind, seismic zone), and occupancy type are confirmed.
  • A licensed structural engineer produces stamped drawings.
  • For pre-engineered kit buildings, the manufacturer’s engineering team handles most of this work.
  • Custom designs with unusual spans, mezzanines, or mixed-use spaces take longer to engineer.

Choose a standard kit if speed is your priority. Standard widths (30 ft, 40 ft, 50 ft, 60 ft) with common roof pitches are pre-engineered and can be drawn up and submitted for permits within a week or two. Custom configurations add 2 to 4 weeks minimum.

Common mistake: Skipping the geotechnical (soil) report to save time. If the permit office or the foundation engineer requests a soil test after submission, it can add 3 to 6 weeks to the schedule.


Why Does Permitting Take So Long, and How Can You Speed It Up?

Permitting is the most unpredictable phase in how long it takes to build a metal building. It can run anywhere from 2 weeks in a rural county with a streamlined process to 12 weeks or more in a dense urban area with multiple review agencies.

Factors that slow permitting:

  • High volume of applications in the local building department
  • Incomplete or non-compliant drawing submissions
  • Zoning variances or conditional use permits required
  • Environmental review triggers (wetlands, flood zones, historic districts)
  • Multiple agency sign-offs (fire marshal, health department, utilities)

Strategies to reduce permit delays:

  1. Submit a complete package the first time. Missing a single document can reset the review clock.
  2. Call the building department before submitting to confirm current requirements.
  3. Ask whether over-the-counter or expedited review is available for your building type.
  4. Hire a local permit expediter if the jurisdiction is known for slow turnaround.
  5. Begin site prep work (clearing, grading) while permits are pending, where local rules allow.

Edge case: Some agricultural metal buildings in rural counties are exempt from standard building permits or require only a simple zoning clearance. Always verify with your local authority before assuming this applies to your project.


How Long Does Site Preparation and Foundation Work Take?

Site preparation typically takes 1 to 2 weeks, and foundation work adds another 1 to 3 weeks, including cure time. These two phases must be complete before any steel arrives on site.

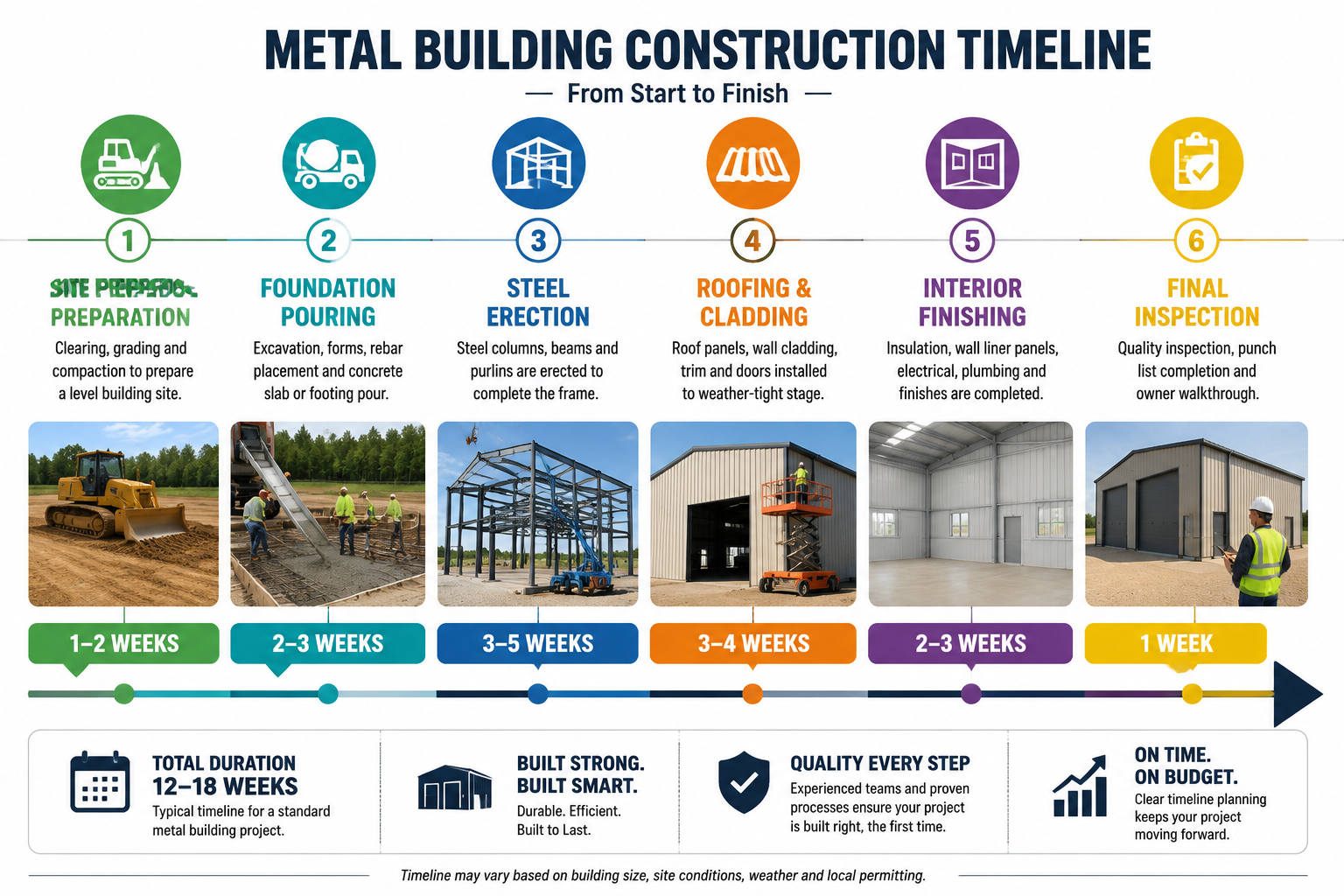

Detailed () informational infographic-style illustration showing a horizontal timeline of metal building construction

Site preparation includes:

  • Clearing vegetation and removing topsoil
  • Grading and leveling the pad area
  • Installing drainage if required
  • Bringing in utilities (power, water, sewer stub-outs)

Foundation types and their timelines:

  • Concrete slab on grade: Most common for metal buildings. Forming, pouring, and curing takes 7 to 14 days. Concrete reaches sufficient strength for steel erection in about 7 days under normal conditions, though full cure is 28 days.
  • Pier and grade beam: Used on sloped sites or in frost-prone areas. Adds 1 to 2 weeks compared to a flat slab.
  • Engineered mat foundation: Required for very large or heavy structures. Can add 3 to 5 weeks.

Weather matters here. Concrete cannot be poured in freezing temperatures without cold-weather precautions, and heavy rain can delay grading work. Scheduling foundation work in spring or fall in northern climates reduces weather risk.


How Long Does Steel Fabrication and Delivery Take?

Steel fabrication typically takes 4 to 10 weeks after engineering drawings are approved and the order is placed. This is often the longest single phase in the project, and it runs in parallel with permitting and site work, which is why smart scheduling can compress the overall timeline.

What affects fabrication lead time:

  • Order backlog at the manufacturer: During high-demand periods (spring and summer), lead times stretch. In 2026, many steel building manufacturers are reporting 6 to 10 week lead times for standard kits due to sustained construction demand.
  • Building complexity: Standard rectangular buildings ship faster than L-shaped, multi-span, or heavily customized structures.
  • Material availability: Steel price volatility and supply chain conditions can affect lead times.

Practical tip: Place your steel order as soon as engineering drawings are approved, even if the permit is still pending. In most cases, you can cancel or adjust the order if the permit is denied, but waiting for the permit before ordering adds weeks to the schedule unnecessarily.


What Is the Actual Steel Erection Timeline Once Materials Arrive?

This is the phase most people picture when they think about how long it takes to build a metal building. Steel erection is fast compared to traditional construction, but the actual duration depends heavily on building size and crew size.

Estimated erection times by building size:

Building Size Crew Size Estimated Erection Time
Under 1,500 sq ft (small garage/shop) 2–4 workers 3–7 days
1,500–5,000 sq ft (commercial shop, barn) 4–6 workers 1–3 weeks
5,000–15,000 sq ft (warehouse, distribution) 6–10 workers 2–5 weeks
15,000+ sq ft (large industrial) 10+ workers 4–8+ weeks

The erection sequence for a typical pre-engineered metal building:

  1. Set anchor bolts (done during foundation phase)
  2. Erect primary steel frames (columns and rafters)
  3. Install secondary framing (purlins, girts, eave struts)
  4. Apply roof panels
  5. Apply wall panels
  6. Install trim, flashing, and doors/windows

Common mistake: Underestimating the time needed for trim and flashing. The shell may look complete, but trim work on a large building can add 3 to 5 days that are easy to forget in early scheduling.


How Long Does Interior Finishing Add to the Total Timeline?

Interior finishing is where the timeline varies most dramatically, because it depends entirely on how the building will be used. A simple agricultural storage building may need no interior work at all. A retail space or office building can require 8 to 12 weeks of additional work after the shell is complete.

Interior finishing tasks and estimated durations:

  • Insulation (batt or spray foam): 3 to 7 days
  • Electrical rough-in and panel installation: 1 to 3 weeks
  • Plumbing rough-in: 1 to 2 weeks (if required)
  • HVAC installation: 1 to 3 weeks
  • Drywall or liner panel installation: 1 to 3 weeks
  • Flooring, painting, fixtures: 1 to 4 weeks
  • Final inspections: 1 to 2 weeks

Choose minimal interior finishing if you’re building a workshop, agricultural building, or storage facility. These can be occupied as soon as the shell is complete and utilities are connected, which dramatically shortens the total project timeline.

Choose full interior finishing if the building will serve as office space, retail, food service, or any occupancy requiring code-compliant HVAC, fire suppression, and ADA accessibility. Budget 3 to 4 months for this phase alone on larger buildings.


What Factors Most Commonly Delay a Metal Building Project?

Even well-planned projects run into delays. Knowing the most common causes helps you build realistic contingency time into your schedule.

Top causes of metal building construction delays:

  1. Permit delays — The single most common cause. Add 2 to 4 weeks of buffer beyond the estimated review time.
  2. Weather — Rain delays grading and concrete work; high winds halt steel erection; extreme cold affects concrete curing.
  3. Subcontractor scheduling conflicts — Electricians, plumbers, and HVAC crews are often booked weeks out.
  4. Change orders — Adding a window, moving a door, or upgrading insulation mid-project causes ripple delays.
  5. Delivery damage or missing components — Pre-engineered kits occasionally arrive with damaged or missing pieces. Replacements can take 2 to 6 weeks.
  6. Soil problems discovered during excavation — Unexpected rock, poor bearing capacity, or high water tables require redesign.
  7. Utility connection delays — Power companies and municipalities set their own schedules.

Decision rule: If your project has a hard deadline (a business opening, a lease expiration, a seasonal deadline), add 20% to your estimated timeline as a buffer and communicate that buffer to your contractor from the start.


How Does a Metal Building Timeline Compare to Traditional Construction?

Metal buildings are generally faster to build than wood-frame or concrete structures of equivalent size, primarily because most of the fabrication work happens off-site in a controlled factory environment.

Comparison by construction type (estimated, for a 5,000 sq ft commercial building):

Construction Type Estimated Total Timeline
Pre-engineered metal building 3–5 months
Wood-frame commercial 5–9 months
Tilt-up concrete 6–10 months
Conventional steel (field-fabricated) 8–14 months

Note: These are general estimates based on industry-reported averages. Actual timelines vary by region, jurisdiction, and project complexity.

The speed advantage of pre-engineered metal buildings is most pronounced during the erection phase. A steel shell that would take a wood-frame crew three months to frame can often be erected in two to four weeks with a pre-engineered kit and an experienced erection crew.

However, the speed advantage shrinks when permitting, site conditions, or interior finishing requirements are similar across building types. The biggest gains come on the shell, not the finish work.


Frequently Asked Questions

Q: How long does it take to erect a small metal garage or workshop?
A small metal building under 1,500 square feet can typically be erected in 3 to 7 days with a crew of 2 to 4 workers. Total project time including foundation and permitting is usually 6 to 10 weeks.

Q: Can I build a metal building faster by using a pre-engineered kit?
Yes. Pre-engineered kits reduce on-site erection time significantly because all components are pre-cut and pre-drilled. The erection phase for a kit building is typically 30 to 50% faster than field-fabricated steel (estimate based on manufacturer-reported comparisons).

Q: How long does concrete need to cure before steel erection begins?
Concrete typically reaches adequate strength for steel erection in about 7 days under normal temperature conditions (above 50°F). Full design strength is reached at 28 days, but most erection crews begin work after the 7-day mark.

Q: Does the time of year affect how long it takes to build a metal building?
Yes. Winter construction in cold climates adds time due to concrete curing challenges and weather delays during erection. Spring and fall are generally the most efficient seasons for metal building construction in northern regions.

Q: How long does it take to get a metal building permit?
Permit timelines range from 2 weeks in rural counties to 12 weeks or more in urban areas with high application volume or complex review processes. Submitting a complete, code-compliant package on the first attempt is the most reliable way to minimize review time.

Q: What is the fastest type of metal building to construct?
A standard rectangular pre-engineered metal building with no interior finishing requirements is the fastest type. A simple agricultural or storage building in this category can go from order to occupancy in as little as 8 to 12 weeks, assuming no permitting delays.

Q: How long does steel fabrication take after I place my order?
Standard pre-engineered building kits typically take 4 to 10 weeks to fabricate and deliver after the order is placed and engineering drawings are approved. Lead times are longer during peak construction seasons.

Q: Can I speed up the timeline by doing some work myself?
Yes, for non-licensed work such as site clearing, grading, and some interior finishing. However, structural steel erection, electrical, plumbing, and HVAC work generally require licensed contractors and inspections, and cutting corners here creates code compliance and safety risks.

Q: How long does interior finishing take for a metal building office space?
Interior finishing for a code-compliant office space typically adds 8 to 14 weeks after the shell is complete, depending on the size of the building and the complexity of the mechanical, electrical, and plumbing systems.

Q: What is the most common reason metal building projects go over schedule?
Permitting delays are the most common cause of schedule overruns, followed by weather-related delays during site preparation and foundation work, and subcontractor scheduling conflicts during interior finishing.


Conclusion: Plan the Timeline Before You Break Ground

Understanding how long it takes to build a metal building means looking at the full project arc, not just the dramatic week when the steel frame goes up. The realistic window for most projects is 2 to 6 months from design to occupancy, with permitting and fabrication lead times accounting for the majority of that calendar time.

Actionable next steps:

  1. Define your occupancy type first. A storage barn and a commercial office shell require very different timelines and budgets. Know which one you’re building before you talk to anyone.
  2. Call your local building department early. Ask about current permit review times, required documents, and whether expedited review is available.
  3. Order your steel as soon as drawings are approved. Don’t wait for the permit to arrive before placing the fabrication order.
  4. Build a 20% time buffer into every phase. Share this buffer with your contractor and set expectations with anyone who depends on your move-in date.
  5. Line up subcontractors before the shell is complete. Electricians, plumbers, and HVAC installers book weeks in advance. Waiting until the steel is up to start calling them adds unnecessary weeks to your schedule.
  6. Get soil testing done early. Discovering a soil problem after permit submission is one of the most expensive and time-consuming delays a metal building project can face.

Metal buildings are genuinely faster to construct than most alternatives, but that speed only materializes when the planning, permitting, and procurement phases are managed with the same discipline as the construction itself.


References


Hank Bridger Avatar

Hank Bridger

Author Metal Building Installer Since 2015, Book Author

Hank Bridger is the founder and lead author of Durapedia. A metal building installer since 2015, Hank has over a decade of hands-on experience erecting residential, agricultural, commercial, and industrial steel structures. Hank is passionate about sharing practical, real-world advice to help readers make informed decisions and avoid costly mistakes with metal buildings.

Areas of Expertise: Author of the popular book Barndominium Reality Check (available on Amazon).

Learn more about my book - Barndominium Reality Check

Learn more about the author

Fact Checked & Editorial Guidelines
Reviewed by: Subject Matter Experts
