Quick Answer: To assemble a metal building kit, you need a prepared concrete foundation, the right hand and power tools, and a crew of at least two to four people. The process follows a fixed sequence: anchor bolts, columns, rafters, wall girts, roof purlins, panels, and trim. Most residential-scale kits (20×30 ft to 40×60 ft) take one to two weekends for an experienced crew, or three to five days for first-timers working carefully with the manufacturer’s erection manual.


Key Takeaways

  • Metal building kits arrive pre-engineered and pre-punched, so no cutting or welding is typically required for standard assembly.
  • A concrete slab with correctly placed anchor bolts is the single most critical prep step — errors here affect every component that follows.
  • Most kits in the 20×40 ft to 40×80 ft range cost between $8,000 and $35,000 for materials only (2026 estimates; prices vary by gauge, region, and supplier).
  • Two to four people can assemble a small-to-mid-size kit without professional help, but larger structures (60 ft wide or more) benefit from a crane or telehandler.
  • Permits are almost always required; skipping them risks fines, forced removal, and insurance gaps.
  • Cold-climate kits need specific insulation packages and snow-load engineering — standard kits may not qualify without upgrades.
  • The most common assembly mistakes are misaligned anchor bolts, skipping plumb checks on columns, and under-torquing fasteners.
  • Workshop and garage applications have different size and door-placement needs — choose accordingly before ordering.

What Tools Do You Need to Put Together a Metal Building Kit?

You don’t need specialized trade tools to assemble most residential or light-commercial metal building kits. The core toolkit consists of standard construction hand tools plus a few power tools.

Essential tools:

  • Cordless drill/driver with metal-rated bits (minimum 18V, preferably 20V)
  • Impact wrench (1/2-inch drive) for structural bolts
  • Torque wrench (calibrated to manufacturer specs — typically 50–75 ft-lbs for 3/4-inch A325 bolts)
  • Chalk line and 100-ft tape measure
  • 4-ft and 8-ft levels (a laser level saves significant time)
  • Framing square
  • Tin snips (aviation-style, left and right cut)
  • Caulking gun and sealant
  • Rubber mallet
  • Safety gear: hard hats, safety glasses, fall-arrest harnesses for roof work, steel-toed boots, cut-resistant gloves

Helpful but optional:

  • Telehandler or rough-terrain forklift (strongly recommended for 40-ft+ wide buildings)
  • Scaffolding or adjustable work platforms
  • Magnetic drill for any field modifications

🔧 Pro tip: Rent a telehandler for at least one day if your kit includes rafters or frames wider than 30 feet. Trying to lift a 300-lb rafter frame by hand with four people is possible but slow and risky.


What Foundation Do You Need Before Installing a Metal Building Kit?

A poured concrete slab with embedded anchor bolts is the standard foundation for metal building kits, and it must be completed and fully cured before any steel goes up. The anchor bolt pattern must match the manufacturer’s base plate drawing exactly — even a half-inch error can prevent columns from seating properly.

Foundation basics:

  • Slab thickness: 4 inches is common for light storage; 5–6 inches for vehicle traffic or heavy equipment.
  • Concrete strength: Minimum 3,000 PSI (most engineers specify 3,500 PSI for commercial use).
  • Anchor bolts: Typically 3/4-inch or 1-inch diameter J-bolts or L-bolts, set in a template frame before the pour.
  • Curing time: Allow a minimum of 7 days before erecting steel; 28 days for full design strength.
Foundation Type Best For Notes
Monolithic slab Most residential kits Most common, cost-effective
Stem wall + slab Sloped lots, flood zones Higher cost, better drainage
Pier/grade beam Expansive soils Requires engineer design
Crushed stone (non-anchored) Temporary structures only Not code-compliant in most areas

Common mistake: Pouring the slab without a bolt template. Always use the manufacturer’s anchor bolt layout drawing and a steel template frame to hold bolts in position during the pour. Bolts that shift even slightly during curing create alignment problems that cascade through the entire assembly.


What Permits Do You Need for a Metal Building Kit?

In nearly every U.S. jurisdiction, a building permit is required for any permanent metal structure, regardless of size. Some counties exempt agricultural buildings under a certain square footage, but this varies significantly by state and municipality.

Typical permit requirements:

  • Building permit: Required in most areas for any structure over 120–200 sq ft.
  • Zoning approval: Confirms the structure is allowed on your property type (residential, agricultural, commercial).
  • Engineered drawings: Most building departments require stamped structural drawings — reputable kit manufacturers provide these as part of the package.
  • Electrical/plumbing permits: Separate permits if you’re adding utilities.
  • HOA approval: If applicable, get written approval before ordering.

📋 Action step: Contact your county building department before ordering your kit. Ask specifically what they require for a pre-engineered metal building. Most kit manufacturers will provide state-stamped drawings for an additional fee, which simplifies the permit process considerably.


How Much Does a Typical Metal Building Kit Cost?

Metal building kit prices in 2026 depend heavily on size, steel gauge, regional demand, and included options. Material-only costs (kit price, not including foundation, labor, or permits) run roughly as follows:

Building Size Estimated Kit Price (2026) Typical Use
20×30 ft $6,000–$12,000 Small garage, storage shed
30×40 ft $10,000–$18,000 Workshop, two-car garage
40×60 ft $18,000–$30,000 Large workshop, small barn
50×100 ft $35,000–$65,000 Commercial, agricultural

These are material-only estimates based on 2026 market pricing from major suppliers. Foundation, labor, permits, insulation, and doors are additional costs.

What drives the price up:

  • Higher snow or wind load engineering
  • Thicker steel gauge (26-gauge vs. 29-gauge panels)
  • Insulation packages
  • Walk doors, windows, and overhead doors
  • Wainscoting, trim colors, and architectural upgrades

What keeps costs down: Ordering a standard “clear-span” design with minimal accessories, buying during off-peak seasons (late fall/early winter), and doing the assembly yourself.


How Long Does It Take to Assemble a Metal Building from a Kit?

Assembly time depends on building size, crew experience, and site conditions. A 30×40 ft kit with a crew of four people who have read the manual and prepped the site properly can realistically be assembled in three to four days. First-timers working on the same size building typically need five to seven days.

General time estimates by building size (4-person crew):

  • 20×30 ft: 2–3 days (experienced), 3–5 days (first-timers)
  • 30×40 ft: 3–4 days (experienced), 5–7 days (first-timers)
  • 40×60 ft: 5–7 days (experienced), 8–12 days (first-timers)
  • 50×100 ft: 10–15 days with equipment (professional crew recommended)

Factors that slow assembly down:

  • Unsorted or mislabeled components (sort everything before Day 1)
  • Missing or damaged pieces (inspect delivery immediately and file claims right away)
  • Weather: wind above 20 mph makes panel installation unsafe
  • Insufficient crew size for the frame width

Can Beginners Really Assemble Their Own Metal Building Kit?

Yes, beginners can successfully assemble a metal building kit, provided the building is under 40 feet wide and they follow the erection manual closely. I’ve seen homeowners with no prior construction experience complete solid 30×40 ft workshops by reading the manual carefully, watching manufacturer installation videos, and taking their time on the foundation and column-plumb steps.

Where beginners succeed:

  • Smaller kits (under 40×60 ft) with clear-span frames
  • Kits from manufacturers with detailed, illustrated erection manuals
  • Projects where the concrete slab was professionally poured
  • Crews of three to four people (not solo)

Where beginners struggle:

  • Wider buildings requiring crane or telehandler operation
  • Kits with complex multi-slope or lean-to designs
  • Sites with significant grade changes
  • Rushing the anchor bolt and column-plumb phase

Can I assemble a metal building kit without professional help? For most residential-scale kits, yes. The assembly process is designed for owner-builders. The two phases where professional help adds the most value are the foundation pour (hire a concrete contractor) and any electrical work inside the finished building.


Are Metal Building Kits Hard to Put Together by Yourself?

Assembling a metal building kit solo is not recommended and, for most frame sizes, is physically impossible for key steps like rafter erection. The minimum practical crew size is two people; three to four is the standard recommendation for kits up to 40×60 ft.

That said, “by yourself” often means “without hiring a contractor” rather than literally one person. With two to four friends or family members and a free weekend, a 30×40 ft kit is a realistic DIY project.

The hardest parts of the assembly process:

  1. Setting and plumbing the first two columns (critical — everything else references these)
  2. Lifting and connecting rafter frames (heaviest, most awkward components)
  3. Installing roof panels safely at height
  4. Achieving consistent fastener torque across hundreds of screws

The easiest parts:

  • Installing wall girts and purlins (bolt-together, clearly labeled)
  • Attaching trim and flashing (mostly self-drilling screws)
  • Installing walk doors and windows (pre-framed openings in most kits)

How to Assemble a Metal Building Kit: The Step-by-Step Process

Here is the standard assembly sequence used for most pre-engineered metal building kits. Follow your specific manufacturer’s erection manual for exact bolt sizes, torque specs, and sequence variations.

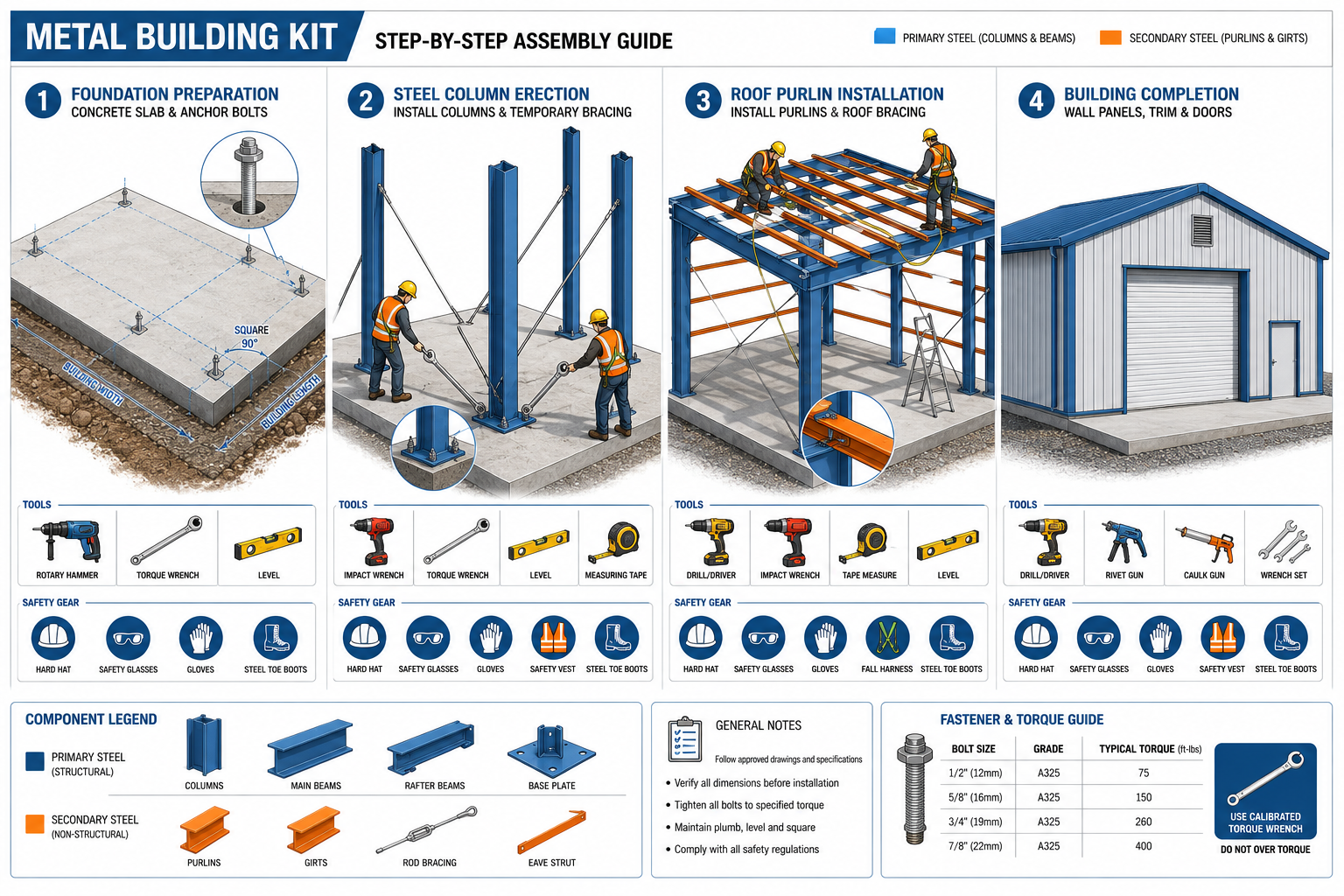

Detailed () step-by-step assembly infographic illustration showing a metal building kit being assembled in four sequential

Step 1: Site Preparation and Material Inspection

Before any steel goes up, verify that your slab is cured, level (within 1/8 inch across the footprint), and that anchor bolts match the layout drawing. Unpack and sort all components by label. Check every piece against the packing list and photograph any damage immediately for warranty claims.

Step 2: Set and Plumb the End-Wall Columns

Start at one end wall. Set the first column over its anchor bolts, hand-tighten the base plate nuts, and use a level on two faces to plumb it. Brace it with a temporary diagonal brace staked to the ground. Repeat for all end-wall columns. Do not fully torque base plate nuts until the entire frame is plumb and square.

Step 3: Erect the End-Wall Rafter Frames

With columns plumb and braced, lift the end-wall rafter (or rigid frame) into position. Connect it to the column tops per the connection detail. Install the knee brace if specified. This step almost always requires at least three people or a telehandler for frames wider than 24 feet.

Step 4: Set Interior Rigid Frames

Interior frames are the widest and heaviest components. Use a telehandler or a gin pole system to lift each frame. Connect to base plates, install temporary cable bracing between frames to hold them plumb, and work bay by bay down the building length.

Step 5: Install Eave Struts, Flange Braces, and Rod Bracing

Eave struts run the full length of the building at the top of the side walls, connecting all frames. Flange braces and diagonal rod bracing are the structural elements that resist lateral wind loads — do not skip or defer these. The building is not structurally stable until all bracing is installed and tensioned.

Step 6: Install Roof Purlins and Wall Girts

Purlins span between frames on the roof; girts span between columns on the walls. Both are typically Z-shaped or C-shaped cold-formed steel sections that bolt to pre-punched clip angles on the frames. Work from eave to ridge on the roof, and from base to eave on the walls.

Step 7: Apply Insulation (If Specified)

If your kit includes a vinyl-faced batt insulation system, install it over the purlins and girts before panel installation. The insulation is draped over the purlins and held in place by the panels as they are installed. This is the easiest time to install it — doing it after panels are on is extremely difficult.

Step 8: Install Roof Panels

Start at the end wall and work toward the opposite end. Lap panels per the manufacturer’s direction (typically one rib overlap). Use the specified self-drilling screws at the correct spacing — over-driving screws compresses the neoprene washer and causes leaks. Install ridge cap and eave trim as you go.

Step 9: Install Wall Panels

Wall panels install similarly to roof panels. Start at a corner, check plumb on the first panel, and work around the building. Trim panels around door and window openings with aviation snips.

Step 10: Install Doors, Windows, Trim, and Sealant

Install pre-hung walk doors and overhead doors per their own instructions. Apply sealant at all trim laps, base trim, and any penetrations. Final-torque all structural bolts to spec and do a complete fastener inspection.


Which Metal Building Kit Is Best for a Workshop vs. a Garage?

The right kit depends on how you’ll use the space. For a workshop, prioritize clear-span width, ceiling height, and side-wall door placement. For a garage, prioritize end-wall overhead door placement, eave height for vehicle clearance, and interior column-free space.

Feature Workshop Priority Garage Priority
Width 30–40 ft (wide work area) 24–30 ft (fits 2–3 vehicles)
Eave height 12–14 ft (equipment clearance) 10–12 ft (standard vehicles)
Door placement Side wall (workflow access) End wall (drive-through)
Overhead doors 1–2 large (10×10 ft+) 2–3 standard (9×8 or 10×10 ft)
Skylights/windows Highly recommended Optional

Choose a workshop-oriented kit if: you need to move large equipment in and out from the side, want natural light for detailed work, or plan to run machinery that requires ventilation on multiple walls.

Choose a garage-oriented kit if: you need drive-through access, plan to store multiple vehicles, or want a simpler rectangular layout with end-wall doors.


How Do I Know What Size Metal Building Kit to Buy for My Property?

Start with your intended use, then add 20–25% to your initial size estimate — most owners report wishing they had gone larger. Also check your local setback requirements (minimum distances from property lines) before finalizing dimensions, as these directly limit your maximum footprint.

Sizing rules of thumb:

  • One vehicle bay: 12 ft wide × 20 ft deep minimum (14×24 ft preferred)
  • Two-car garage: 24 ft wide × 24–30 ft deep
  • Workshop with workbenches on two walls: 30 ft wide × 40 ft deep minimum
  • Small agricultural storage: 40×60 ft to 50×80 ft
  • Light commercial: 50×100 ft and up

Property constraints to check first:

  1. Zoning setbacks (front, rear, side yard minimums)
  2. Maximum lot coverage percentage
  3. HOA restrictions on accessory structures
  4. Utility easements (you cannot build over them)
  5. Septic system location (required clearance in most states)

Are Metal Building Kits Good for Cold Climate Areas?

Metal building kits can perform very well in cold climates, but only when ordered with the correct snow load rating and an appropriate insulation system. A standard kit designed for a mild climate will not meet code in Minnesota or Montana without engineering upgrades.

What to specify for cold climates:

  • Snow load: Order to your local ground snow load (Pg) value, available from your county building department or ASCE 7 maps. Common values range from 20 PSF in moderate climates to 70+ PSF in heavy snow regions.
  • Insulation: A minimum of R-19 batt insulation in the roof and R-13 in the walls is typical for heated buildings in cold climates; R-38 roof insulation is common in northern states.
  • Condensation control: Vapor barriers and proper ventilation prevent the interior condensation that accelerates corrosion in cold, humid conditions.
  • Thermal bridging: Metal conducts heat efficiently, so thermal break tape at girts and purlins reduces heat loss significantly.

Cold-climate metal buildings are not inherently inferior to wood-frame structures — they can actually outperform them in heavy snow because the engineered steel frame is designed to specific load values, unlike stick-built structures that rely on conservative rule-of-thumb framing.


What Are the Most Common Mistakes When Assembling Metal Building Kits?

The most costly mistakes in metal building assembly happen in the first 10% of the project, specifically during foundation prep and column erection. Errors at this stage compound through every subsequent step.

Top mistakes and how to avoid them:

  1. Anchor bolts out of position: Use a steel template and double-check dimensions before the concrete pour. Have someone verify the layout independently.
  2. Skipping plumb checks on columns: Check plumb on two perpendicular faces. A column that’s 1/4 inch out of plumb at 10 feet creates significant alignment problems at the roof.
  3. Under-torquing structural bolts: Use a calibrated torque wrench. “Tight enough by feel” is not adequate for structural connections.
  4. Over-driving panel screws: The neoprene washer should compress slightly, not flatten. Over-driven screws leak.
  5. Installing panels before all bracing is complete: The building frame is not stable without its rod bracing. Wind can rack an unbraced frame.
  6. Not sorting components before starting: Searching for labeled parts mid-assembly wastes hours. Sort everything by component type on Day 1.
  7. Ignoring the erection manual sequence: The sequence exists for structural and safety reasons. Skipping steps to save time creates rework.

FAQ: How to Assemble a Metal Building Kit

Q: Do metal building kits come with all the hardware I need?
A: Yes, reputable kits include all structural bolts, self-drilling screws, and trim fasteners. Confirm this with your supplier before ordering, as some budget kits exclude fasteners.

Q: Can I add a lean-to or extension to a metal building kit later?
A: Yes, most manufacturers design their buildings to accept future lean-to additions. Specify this at the time of order so the correct framing clips and wall panel prep are included.

Q: How long do metal building kits last?
A: A properly assembled and maintained metal building with a Galvalume or painted steel panel system can last 40–60 years. The structural frame, if kept dry and protected from corrosion, can last much longer.

Q: Do I need to paint or coat the steel after assembly?
A: Factory-applied coatings on panels and trim are designed to be maintenance-free for 25–40 years under normal conditions. Touch up any scratches or cut edges with the manufacturer’s touch-up paint to prevent rust.

Q: Can a metal building kit be assembled on a gravel pad instead of concrete?
A: Gravel pads are used for temporary or non-permitted structures only. Most building codes require a concrete foundation for permitted permanent structures.

Q: What is the minimum crew size to assemble a metal building kit?
A: Two people is the absolute minimum for a very small kit (20×20 ft or less). Three to four people is the practical minimum for anything larger, and five to six is more efficient for 40×60 ft and above.

Q: Are metal building kits fire-resistant?
A: Steel is non-combustible, which gives metal buildings a significant fire-resistance advantage over wood-frame structures. However, insulation materials vary in fire rating — specify fire-rated insulation if this is a priority.

Q: How do I find a reputable metal building kit supplier?
A: Look for suppliers who are members of the Metal Building Manufacturers Association (MBMA) and who provide state-stamped engineered drawings as a standard offering. Ask for references from completed projects in your region.

Q: What happens if a piece is missing or damaged on delivery?
A: Document all damage with photos at delivery, note it on the bill of lading before the driver leaves, and contact the manufacturer’s customer service immediately. Most reputable suppliers ship replacement parts within one to two weeks.

Q: Can I insulate a metal building kit after assembly?
A: Yes, but it’s significantly harder. Spray foam applied to the interior is the most practical retrofit option. Installing batt insulation after panels are on requires removing and reinstalling panels, which is costly.


Conclusion: Your Action Plan for Assembling a Metal Building Kit

Learning how to assemble a metal building kit is a genuinely achievable project for motivated owner-builders, and the savings over hiring a general contractor can be substantial. The key is preparation: get the foundation right, sort your materials before you start, follow the erection sequence in your manual, and never skip the plumb checks or bracing steps.

Your next steps:

  1. Define your use case and size using the sizing guidelines above, then add 20% for future needs.
  2. Check local zoning and setbacks before ordering — this determines your maximum footprint.
  3. Get your permit requirements in writing from your county building department.
  4. Request quotes from at least three suppliers, comparing included engineering drawings, warranty terms, and fastener packages.
  5. Hire a concrete contractor for the slab and anchor bolt pour — this is the one phase where professional execution pays for itself.
  6. Recruit your crew and schedule a pre-assembly day to sort and inventory all components.
  7. Read the erection manual cover to cover before Day 1 of assembly.

A well-assembled metal building kit delivers decades of reliable, low-maintenance service. Take your time on the foundation and frame-plumb phases, and the rest of the assembly will go smoothly.


References

  • Metal Building Manufacturers Association (MBMA). Metal Building Systems Manual. MBMA, 2021. https://www.mbma.com
  • American Institute of Steel Construction (AISC). Steel Construction Manual, 16th Edition. AISC, 2023. https://www.aisc.org
  • American Society of Civil Engineers. ASCE 7-22: Minimum Design Loads and Associated Criteria for Buildings and Other Structures. ASCE, 2022. https://www.asce.org
  • U.S. Department of Energy. Insulation Fact Sheet: Steel-Frame Construction. DOE Office of Energy Efficiency & Renewable Energy, 2020. https://www.energy.gov

Hank Bridger Avatar

Hank Bridger

Author Metal Building Installer Since 2015, Book Author

Hank Bridger is the founder and lead author of Durapedia. A metal building installer since 2015, Hank has over a decade of hands-on experience erecting residential, agricultural, commercial, and industrial steel structures. Hank is passionate about sharing practical, real-world advice to help readers make informed decisions and avoid costly mistakes with metal buildings.

Areas of Expertise: Author of the popular book Barndominium Reality Check (available on Amazon).

Learn more about my book - Barndominium Reality Check

Learn more about the author

Fact Checked & Editorial Guidelines
Reviewed by: Subject Matter Experts
