Last updated: May 21, 2026
Quick Answer
A small DIY metal building (under 1,000 sq ft) typically takes one to three weekends for a crew of two to four people, assuming the foundation is already cured. Larger structures such as metal barns or commercial-grade buildings can take two to eight weeks of part-time work. The total time depends on building size, crew experience, site conditions, and how much foundation and permitting work is required before assembly begins.
Key Takeaways
- A 12×20 ft metal garage kit can be assembled by two people in roughly 16–24 hours of active work, spread across two weekends.
- Larger metal buildings (40×60 ft and above) realistically require 4–8 weeks of part-time effort or 5–10 full working days with a crew of four or more.
- Foundation and permitting are the biggest time variables — they can add 2–6 weeks before a single panel goes up.
- Metal building kits are generally faster to assemble than comparable wood-frame structures because components are pre-engineered and pre-cut.
- Weather delays are common; rain, high winds, and extreme cold can each pause or slow assembly significantly.
- No specialized trade license is required for most DIY metal building kits, but basic mechanical aptitude and comfort with heights are necessary.
- Hiring two to four helpers is the single most effective way to cut assembly time in half.
- The most time-consuming phases are foundation prep, anchor bolt setting, and roofing panel installation.
- A beginner with a good kit and a helper can reasonably complete a 20×20 ft building over three to four weekends.
- Self-built metal buildings last 40–60 years when properly erected and maintained, comparable to professionally installed structures.
How Long Does It Take to Build a Metal Building Yourself?
The honest answer is that how long DIY metal buildings take depends heavily on three variables: the size of the structure, the experience of the crew, and how much pre-assembly site work is needed. For most homeowners tackling a first project, expect the full process — from breaking ground to moving in equipment — to take four to ten weeks total, even if active assembly only takes a few days.
Here is a rough breakdown by building size for a crew of two to four people with basic construction experience:

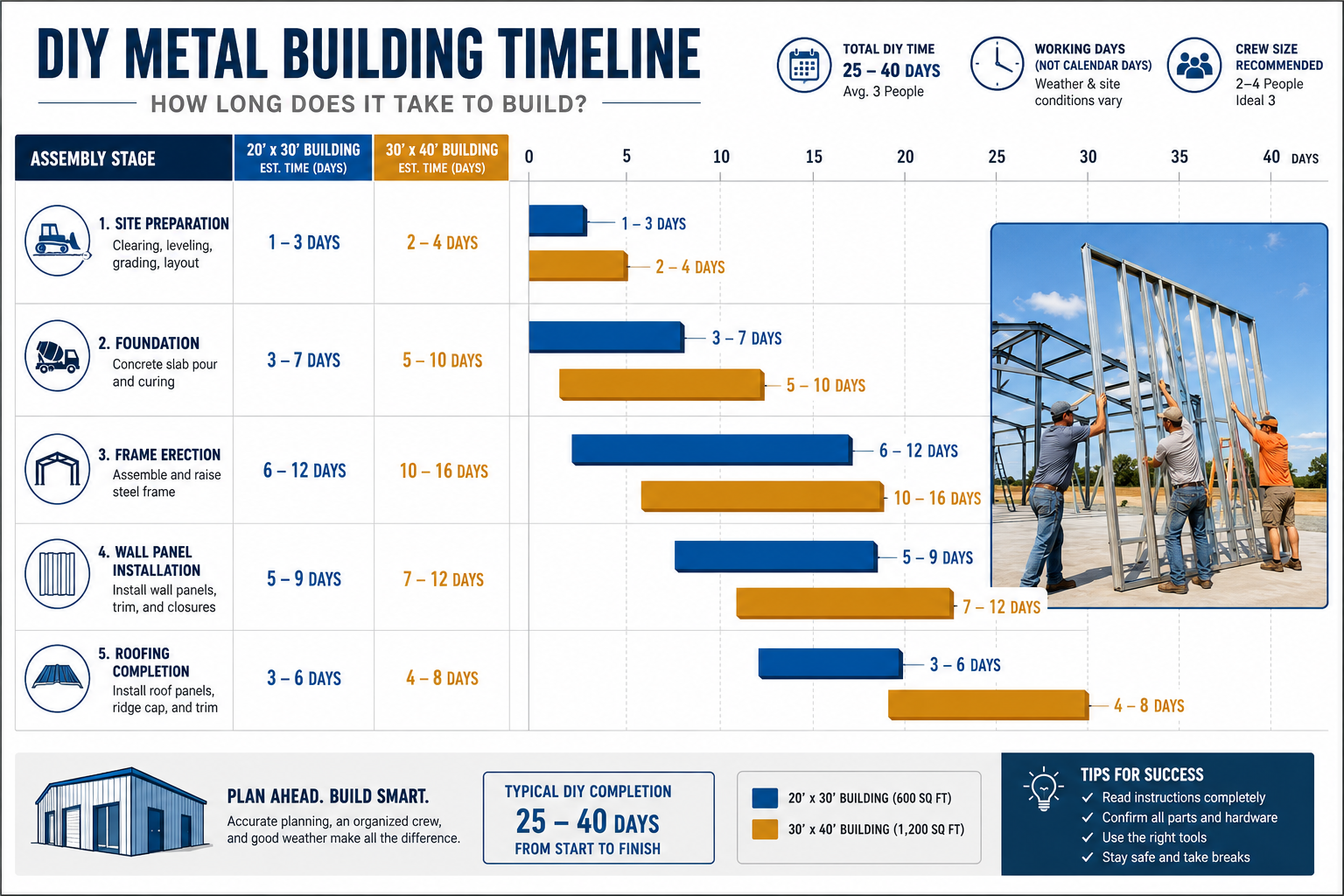

| Building Size | Active Assembly Time | Total Project Time (incl. site prep) |
|---|---|---|
| 12×20 ft (small garage) | 16–24 hours | 2–4 weeks |
| 20×30 ft (workshop) | 24–40 hours | 3–6 weeks |
| 30×40 ft (large garage/barn) | 40–60 hours | 4–8 weeks |
| 40×60 ft (commercial/barn) | 60–100 hours | 6–12 weeks |
| 60×100 ft (large barn/warehouse) | 100–160+ hours | 10–20 weeks |
Note: These estimates assume a pre-engineered bolt-together kit on a flat, accessible site. Custom fabrication, sloped sites, or complex foundation requirements will add time.
What Are the Typical Steps in a DIY Metal Building Project?
Every DIY metal building project follows a predictable sequence. Skipping or rushing any step is the most common cause of delays and structural problems.
The standard sequence is:
- Planning and permitting (1–4 weeks): Pull building permits, submit site plans, and confirm setback requirements with your local authority. This phase is entirely outside your control once submitted.
- Site preparation (2–5 days): Clear and level the building site, establish drainage, and mark anchor bolt locations.
- Foundation work (3–10 days including cure time): Pour a concrete slab or set concrete piers. Concrete typically needs 7 days minimum cure time before loading, and 28 days for full strength.
- Anchor bolt inspection (1 day): Verify bolt placement matches the building’s base plate layout before the slab cures fully.
- Kit delivery and inventory (1 day): Receive the building kit, check all components against the manifest, and stage materials near the build site.
- Frame erection (1–3 days): Set primary frames, columns, and rafters. This is the most physically demanding phase.
- Secondary framing (1–2 days): Install girts, purlins, and eave struts that connect primary frames.
- Wall and roof panel installation (2–4 days): Attach metal panels, starting with walls and finishing with roof sheets.
- Trim, flashing, and doors (1–2 days): Install ridge cap, corner trim, gutters, walk doors, and roll-up doors.
- Final inspection and cleanup (1 day): Schedule any required municipal inspection and address punch-list items.
Common mistake: Many first-timers underestimate the foundation cure window. Pouring concrete and expecting to start framing the next day is a reliable way to compromise your slab and your timeline.
How Much Time Should I Budget for a Metal Garage Versus a Metal Barn?
A metal garage and a metal barn differ in size, height, and structural complexity, which directly affects how long DIY metal buildings take to complete.
Metal garages (typically 12×20 to 24×30 ft) are the most beginner-friendly category. A two-car metal garage kit can be assembled by two capable adults in a single long weekend of active work, though total project time including foundation is usually three to five weeks.
Metal barns are a different challenge. A standard 40×60 ft agricultural barn with 14-ft sidewalls involves heavier primary frames, more panels, and often requires a forklift or telehandler to lift frame sections safely. Budget 6–12 weeks total for a barn of this size, with active assembly taking 8–15 full working days for a crew of four.
Key differences at a glance:
- Garage kits are lighter, have fewer components, and are easier to manage without heavy equipment.
- Barn kits often require equipment rental (forklift, scissor lift) which adds cost and scheduling complexity.
- Clearspan barns (no interior columns) have heavier, wider primary frames that are harder to handle manually.
- Multi-use barns with lean-tos or attached shelters add 30–50% more assembly time.
Decision rule: If your building footprint exceeds 2,400 sq ft or your eave height exceeds 12 feet, plan for equipment rental and budget at least two additional days for that logistics alone.
What Tools Do I Need to Speed Up Metal Building Construction?
Having the right tools is one of the most controllable factors in how long DIY metal buildings take. Missing a key tool on assembly day can cost half a day of productivity.
Essential tools for any metal building project:
- Cordless impact driver (18V minimum, two recommended): Drives self-drilling screws far faster than a standard drill.
- Magnetic screw tray and bit holder: Prevents dropped fasteners on the roof.
- Chalk line and laser level: Critical for keeping panels plumb and square.
- Torque wrench: Required for anchor bolts and primary frame connections.
- Tin snips and metal nibbler: For trimming panels to fit around openings.
- Extension ladders and scaffolding: Non-negotiable for safe panel installation above 10 feet.
- Come-along or cable puller: Useful for pulling frames plumb during erection.
- Telehandler or forklift (rental): For buildings over 30 ft wide, this cuts frame erection time by 50% or more.
Speed tip: Renting a telehandler for a single day (typical cost: $400–$800/day in 2026, depending on region) can save two to three days of manual lifting on a mid-size barn project. The math almost always favors the rental.

Are DIY Metal Buildings Harder to Build Than Traditional Wood Structures?
For most people with basic construction skills, DIY metal buildings are actually easier and faster to assemble than comparable wood-frame structures. The key reason is that pre-engineered metal building kits arrive with components already cut, drilled, and labeled. There is no framing lumber to cut, no rafter angles to calculate, and no sheathing to measure and rip.
Where metal buildings are easier than wood:
- No custom cutting of structural members on site.
- Bolt-together connections are simpler than nailing or complex joinery.
- Pre-punched holes eliminate most layout work.
- Engineered drawings are included, reducing design guesswork.
Where metal buildings are harder than wood:
- Metal panels are slippery and unforgiving in wind — a gust can turn a roof panel into a sail.
- Fastener placement must be precise; over-driving screws strips the panel and causes leaks.
- Corrections are harder: a misplaced anchor bolt in concrete is a serious problem, while a misplaced wood stud is a minor one.
- Working at height with large, rigid panels is more physically demanding than framing with lumber.
Bottom line: Metal building kits reduce the skill ceiling but raise the stakes for precision in the foundation and framing phases. A careful, methodical builder will find metal kits very manageable.
How Long Will a Self-Built Metal Building Last Compared to Professional Installation?
A properly self-built metal building will last just as long as a professionally installed one — typically 40 to 60 years for a quality galvanized steel structure — provided the foundation is correct and the panels are fastened per the manufacturer’s specifications.
The longevity gap, when it exists, almost always traces back to two issues: anchor bolt misalignment (which puts chronic stress on the frame) and improper screw installation (which allows water infiltration at panel seams). Both are preventable with careful work and a willingness to re-read the installation manual.
Factors that affect long-term durability regardless of who builds it:
- Steel gauge (29-gauge panels are thinner and less durable than 26-gauge)
- Coating quality (Galvalume and Kynar 500 finishes outperform standard painted coatings)
- Foundation quality (a cracked or settling slab will rack the frame over time)
- Local climate (coastal salt air, heavy snow loads, and freeze-thaw cycles accelerate wear)
- Annual maintenance (re-torquing loose screws, touching up paint chips, clearing debris from gutters)
Professional installation advantage: A professional crew has done the same assembly dozens of times and catches mistakes before they become permanent. A DIY builder on a first project may not recognize a plumb issue until several frames are up. That said, the manufacturer’s manual and a careful read of the engineering drawings close most of that gap.
What Mistakes Slow Down Metal Building Assembly?
The most common mistakes that extend how long DIY metal buildings take are almost entirely avoidable with planning. Here are the ones that consistently cost builders the most time.
Top time-wasting mistakes:
- Anchor bolts out of position: If bolts are set even half an inch off the plan, base plates won’t align. Fixing this after the slab cures can mean cutting and re-drilling — a half-day or full-day delay.
- Not staging materials before assembly: Hunting for the right panel or hardware mid-build kills momentum. Spend two hours pre-sorting and labeling components the day before assembly.
- Working with too small a crew: Two people can build a small garage, but they will spend a lot of time holding one thing while the other fastens it. Four people is the practical minimum for a building over 30 ft wide.
- Skipping the dry-fit step: On primary frames, loosely assembling before final torquing lets you catch alignment issues without consequence.
- Ignoring the weather forecast: Starting roof panel installation with a wind advisory in effect is dangerous and slow. Check the forecast three days out.
- Not reading the manual before starting: The installation sequence in a metal building manual is engineered, not arbitrary. Deviating from it — for example, installing wall panels before the frame is fully braced — can cause the structure to rack.
How Much Faster Is Metal Building Construction Than Traditional Construction?
Metal building construction is generally 30–50% faster than equivalent wood-frame construction for structures in the agricultural, commercial, and light industrial categories. The primary reason is that pre-engineered kits eliminate on-site fabrication of structural components.
A traditional wood-frame workshop of 30×40 ft might take a skilled crew 10–15 days to frame, sheath, and roof. An equivalent metal building kit, with the same crew, can be framed and paneled in 5–8 days. The time savings compound when you factor in that metal buildings rarely require the same level of interior finishing (insulation batts, drywall, vapor barriers) that wood structures need to prevent moisture damage.
Where traditional construction is faster:
- Small sheds under 200 sq ft (simple wood construction can be faster than reading a metal kit manual for the first time)
- Structures requiring heavy interior customization (wood is easier to modify on the fly)
- Projects where a concrete slab is not practical (wood post-frame construction can go on gravel or compacted base)
What Size Metal Building Can a Beginner Reasonably Complete in a Weekend?
A beginner with one capable helper can realistically complete the assembly of a 12×20 ft to 16×24 ft metal building kit over a single long weekend (Friday evening through Sunday), assuming the foundation is already cured and materials are staged.
This size range is the sweet spot for first-time builders because:
- Primary frames are light enough to lift and hold manually without equipment.
- The total panel count is manageable (typically 20–40 panels).
- Mistakes are easier to spot and correct before they compound.
- The total fastener count is in the hundreds, not thousands.
What “a weekend” actually looks like:
- Friday evening (2–3 hours): Inventory components, sort hardware, set up scaffolding.
- Saturday (8–10 hours): Set primary frames, install secondary framing, begin wall panels.
- Sunday (8–10 hours): Complete wall panels, install roof panels, attach trim and doors.
Anything larger than a 20×24 ft footprint will almost certainly spill into a third or fourth weekend for a two-person beginner crew. That is not a failure — it is a realistic expectation.
Do I Need Special Skills or Experience to Build a Metal Building Myself?
No trade license or specialized certification is required to assemble a pre-engineered metal building kit in most jurisdictions, but a baseline of practical skills makes the difference between a smooth project and a frustrating one.
Skills that genuinely help:
- Comfort reading technical drawings and assembly manuals
- Basic comfort with heights (roof work is unavoidable)
- Familiarity with power tools, particularly impact drivers
- Understanding of how to use a level and chalk line
- Basic concrete knowledge (for anchor bolt setting)
Skills you do NOT need:
- Welding (bolt-together kits require no welding)
- Electrical or plumbing (unless you’re adding utilities, which is a separate project)
- Crane operation (for buildings under 40 ft wide, a telehandler or manual lifting is sufficient)
Honest assessment: A person who has built a deck, hung drywall, or done basic home renovation work has enough foundational skill to complete a small to mid-size metal building kit. The learning curve is steepest in the first building — the second one typically goes 40–60% faster.
How Do Weather Conditions Impact DIY Metal Building Timelines?
Weather is the most unpredictable factor in how long DIY metal buildings take, and it affects every phase of the project differently.
Rain: Delays concrete pours and extends cure time. Standing water on a slab before full cure can weaken the surface. During assembly, rain makes metal panels slippery and dangerous.
Wind: The most operationally disruptive condition. Metal panels act as sails — a 20 mph gust can make a 10-ft roof panel impossible to control safely. Most experienced builders pause roof panel installation when sustained winds exceed 15 mph.
Extreme heat: Affects worker endurance and can cause metal panels to expand slightly during installation, leading to fit issues if the temperature swings significantly between installation and cooler nighttime temperatures.
Extreme cold: Concrete pours below 40°F (4°C) require special additives and curing blankets. Impact drivers lose battery efficiency. Metal becomes more brittle and fastener seating is less consistent.
Best building seasons: Late spring and early fall offer the most predictable conditions in most of North America. Planning your assembly phase for May–June or September–October reduces weather-related delays significantly.
What Are the Most Time-Consuming Parts of Metal Building Assembly?
The three most time-consuming phases of any DIY metal building project are foundation work, primary frame erection, and roof panel installation. Together, these three phases typically account for 70–80% of total active build time.
Foundation work is slow because concrete has a non-negotiable cure timeline. You cannot rush chemistry. Anchor bolt placement must be perfect before the concrete sets, which means careful measurement and double-checking under time pressure.
Primary frame erection is physically demanding and requires the most coordination among crew members. Each frame must be plumbed, squared, and temporarily braced before the next one goes up. Rushing this phase creates alignment problems that cascade through every subsequent step.
Roof panel installation is slow for two reasons: working at height requires more caution, and every panel must be aligned with the previous one to maintain consistent rib spacing and prevent leaks at overlaps. A misaligned panel discovered three panels later means backtracking.
Fastest phases: Secondary framing (girts and purlins) and wall panels go up relatively quickly once the primary structure is plumb and braced.
Can I Hire Help to Speed Up My DIY Metal Building Project?
Yes, and for most projects over 20×30 ft, hiring additional helpers is the single most cost-effective decision you can make. Doubling your crew from two to four people does not just double your speed — it often triples it, because many tasks require three or four hands simultaneously.
Options for hiring help:
- Friends and family: The most economical option. Offer meals, beverages, and reciprocal help on their projects. Be realistic about skill levels and assign tasks accordingly.
- Day laborers: Available through staffing agencies or local labor markets. Effective for physically demanding tasks like panel carrying and staging. Less effective for precision work like anchor bolt setting.
- General contractors for specific phases: Hiring a concrete contractor for the foundation only is a common and smart approach. They bring their own tools, expertise, and speed. The rest of the project remains DIY.
- Metal building erection crews: Some suppliers offer partial erection services. You can hire them for frame erection only and handle panels and trim yourself. This hybrid approach reduces total cost while eliminating the hardest phase.
Important note: Even if you hire helpers for physical labor, the project manager role — reading drawings, verifying dimensions, and making calls on sequencing — should remain with the person who has studied the plans. Miscommunication between an inexperienced crew and an absent project manager is a reliable source of costly errors.
FAQ: How Long DIY Metal Buildings Take
Q: How long does it take to build a 30×40 metal building?
A: A 30×40 ft metal building takes a crew of three to four people approximately 40–60 hours of active assembly time. With site prep and foundation cure time, budget 5–8 weeks total from project start to completion.
Q: Can one person build a metal building alone?
A: A single person can assemble a very small metal carport or shed kit (under 200 sq ft), but any building with full-height walls and a roof requires at least two people for safe panel handling. Three to four people is the practical minimum for anything 20×20 ft or larger.
Q: How long does a metal building foundation take?
A: Pouring a concrete slab foundation takes one to two days of active work, but concrete requires a minimum of 7 days of cure time before loading, and 28 days to reach full design strength. Plan your schedule around the cure window, not the pour date.
Q: Do metal building kits come with instructions?
A: Yes. Reputable pre-engineered metal building manufacturers include detailed erection manuals with step-by-step sequences, component diagrams, and fastener schedules. Reading the full manual before starting is strongly recommended.
Q: How long does it take to get a metal building permit?
A: Permit timelines vary widely by jurisdiction. In rural counties, permits may be issued in 3–5 business days. In urban or suburban areas, plan for 2–6 weeks. Some jurisdictions require engineered stamped drawings, which adds time and cost.
Q: What is the fastest type of metal building to assemble?
A: Single-slope (lean-to) and simple gable-roof carport kits are the fastest to assemble. A 12×20 ft single-slope carport can be erected by two people in 6–10 hours. Clearspan rigid-frame buildings take longer because the primary frames are heavier and require more precise alignment.
Q: Does a metal building kit include all hardware?
A: Most kits include all structural hardware (bolts, base plates, screws). Anchor bolts are sometimes sold separately or specified but not included. Always verify the kit manifest before ordering and confirm what is and is not included with your supplier.
Q: How long does roof panel installation take on a metal building?
A: Roof panel installation typically takes one to two full days for a 30×40 ft building with a crew of three. Larger buildings or steeper pitches add time. Wind conditions are the biggest variable — a calm day can cut this phase’s time by 30%.
Q: Is a metal building harder to insulate than a wood building?
A: Metal buildings require different insulation approaches (vinyl-faced fiberglass batts or spray foam) to prevent condensation on the metal skin. This adds a step that wood buildings handle differently, but it is not significantly harder — just different.
Q: How long do metal building panels last before needing replacement?
A: High-quality Galvalume or Kynar-coated steel panels typically last 40–60 years before requiring replacement, assuming no major physical damage. Painted panels may need recoating after 20–30 years depending on climate and coating quality.
Conclusion: Plan Realistically, Build Confidently
Understanding how long DIY metal buildings take is the foundation of a successful project. The biggest source of frustration for first-time builders is not the assembly itself — it is the gap between optimistic timelines and the reality of foundation cure windows, permit delays, and weather interruptions.
Actionable next steps:
- Define your building size and use case before requesting quotes. Knowing your footprint, eave height, and intended use lets suppliers give you accurate kit specifications.
- Contact your local building department first. Confirm permit requirements, setback rules, and whether engineered drawings are required. Do this before spending any money on a kit.
- Plan your foundation separately. Get a concrete contractor quote for the slab. Even if you pour it yourself, get a professional to verify your anchor bolt layout before the pour.
- Assemble a crew of at least three people for any building over 20×24 ft. Identify who is available and confirm their schedule before you set a build date.
- Order your kit 6–10 weeks before your target assembly date. Lead times for pre-engineered kits in 2026 range from 4–10 weeks depending on the manufacturer and season.
- Read the erection manual cover to cover at least one week before assembly begins. Flag any steps that require tools or equipment you don’t have.
A well-planned DIY metal building project is genuinely achievable for most capable adults. The buildings are durable, cost-effective, and faster to erect than most people expect — as long as expectations are grounded in realistic timelines from the start.
Sources
- Steel Building Systems, General Services Administration (GSA) Technical Reference Guide. https://www.gsa.gov (2019)
- American Institute of Steel Construction (AISC), Steel Construction Manual, 16th Edition. https://www.aisc.org (2023)
- Metal Building Manufacturers Association (MBMA), Metal Building Systems Manual. https://www.mbma.com (2022)
- Portland Cement Association, Concrete Curing Methods and Materials. https://www.cement.org (2020)
- Occupational Safety and Health Administration (OSHA), Steel Erection Standard (29 CFR 1926 Subpart R). https://www.osha.gov (2001, updated 2019)
