Quick Answer
Building a metal building is significantly more involved than most first-timers expect. The base kit price is just one piece of a total project cost that typically runs 30–60% higher once foundation work, permits, insulation, and finishing are factored in. Before you commit, you need a clear picture of zoning rules, site preparation requirements, and the real difference between a bare steel shell and a finished, usable structure.
Key Takeaways
- Base kit prices are misleading. A metal building kit may cost $15–$25 per square foot, but the all-in project cost often lands between $35 and $70+ per square foot depending on finish level and location.
- Permits and zoning can stop a project cold. Many rural and suburban areas have specific setback rules, height limits, or outright restrictions on metal structures.
- Metal buildings work well in cold climates — but only with proper insulation and vapor barrier systems. Skipping insulation is the most expensive mistake beginners make.
- DIY assembly is possible for small structures, but most buildings over 40 feet wide benefit from professional erection crews.
- Foundation type matters more than most people realize. A slab, pier, or perimeter foundation must match the building’s load specifications exactly.
- Metal buildings last 40–60+ years with basic maintenance, outperforming wood-frame structures in longevity and pest resistance.
- Unexpected costs — delivery, site prep, electrical, HVAC, and interior finishing — routinely add $10,000–$50,000 to a project budget.
- Maintenance is low but not zero. Annual inspections, sealant checks, and touch-up paint prevent the vast majority of long-term issues.
- Metal buildings are excellent for workshops, garages, and agricultural use — and increasingly viable for residential and commercial applications.
- Pole barns and prefab metal buildings are fundamentally different products with different cost structures, lifespans, and use cases.
How Much Does a Metal Building Actually Cost Per Square Foot?
A metal building kit typically costs between $15 and $25 per square foot for the steel package alone (as of 2026 estimates from major suppliers). However, the all-in construction cost — including foundation, erection labor, insulation, electrical, and finishing — generally runs $35 to $70 per square foot for a basic commercial or agricultural structure. Residential-grade metal buildings with full interior finishing can exceed $100 per square foot.

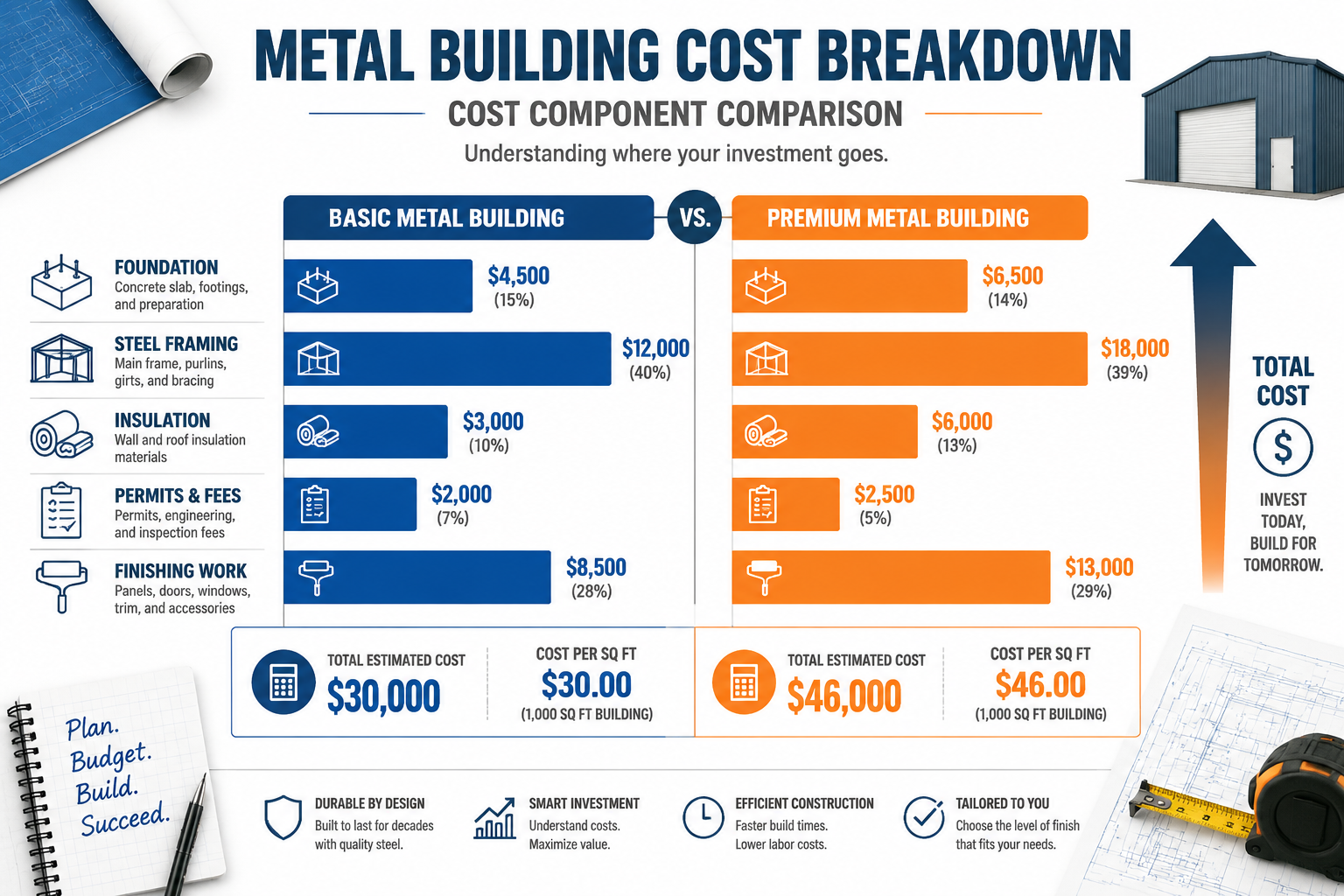

Here is a rough cost breakdown for a 2,400 sq. ft. metal building (40×60 footprint) as a planning reference:
| Cost Component | Estimated Range |
|---|---|
| Steel building kit | $18,000 – $36,000 |
| Site preparation & grading | $3,000 – $12,000 |
| Concrete slab foundation | $12,000 – $22,000 |
| Erection labor | $8,000 – $18,000 |
| Insulation (spray foam or blanket) | $5,000 – $15,000 |
| Electrical rough-in | $4,000 – $10,000 |
| Doors, windows, trim | $3,000 – $8,000 |
| Permits and engineering | $1,500 – $5,000 |
| Total estimated range | $54,500 – $126,000 |
⚠️ Common mistake: Many first-time buyers see a $20,000 kit price and assume that is the project cost. The kit is the steel — not the building. Budget for everything above the kit price before you commit.
Choose a higher budget range if: your site has poor drainage, significant slope, or rocky soil; you are in a high-cost-of-labor metro area; or you want a fully finished interior with HVAC.
What Are the Biggest Mistakes People Make When Planning a Metal Building?
The most common planning mistakes fall into three categories: underestimating total cost, skipping professional engineering review, and ordering the wrong size. Each of these is avoidable with upfront research.
Top mistakes to avoid:
- Ordering before confirming permits. Some counties require engineered drawings before issuing a permit. If your building does not meet local wind and snow load codes, you may need a costly redesign.
- Forgetting the concrete. The slab or foundation is often the single largest line item and is almost never included in kit pricing.
- Underinsulating. A bare steel shell conducts heat and cold aggressively. Skipping insulation creates condensation problems that corrode the structure from the inside.
- Choosing the wrong gauge steel. Lighter gauge (thinner) steel costs less upfront but may not meet local building codes for wind or snow loads.
- Not accounting for delivery logistics. Long steel panels require flatbed trucks and clear site access. Narrow driveways or overhead obstacles can delay delivery and add fees.
- Sizing too small. The single most common regret I hear from metal building owners is: “I wish I’d gone bigger.” Adding square footage later is expensive.
- Ignoring the trim package. Trim, gutters, and downspouts are often sold separately and are essential for weather performance.
Are Metal Buildings Good for Cold Climates or Just Warm Areas?
Metal buildings perform well in cold climates when properly insulated and designed for local snow and wind loads. The steel frame itself is not the problem — inadequate insulation and vapor barriers are. Without a proper thermal envelope, condensation forms on the interior steel surfaces, accelerating corrosion and creating moisture damage.
For cold-climate metal buildings, these elements are non-negotiable:
- Vapor barrier: Installed between the insulation and the steel to prevent condensation.
- R-value appropriate insulation: Most cold-climate applications require a minimum R-19 wall insulation and R-30+ roof insulation. Check local energy codes for your specific zone.
- Snow load engineering: Metal building kits must be ordered to match local ground snow load requirements. In the northern United States and Canada, this is a critical spec — not an optional upgrade.
- Heated foundation: In permafrost-adjacent or extreme cold regions, a frost-protected shallow foundation or heated slab may be required.
Edge case: In areas with very high humidity combined with cold winters (such as the upper Midwest), spray foam insulation often outperforms fiberglass blanket insulation because it eliminates air gaps where condensation can form.
Can I Build a Metal Building Myself, or Do I Definitely Need a Contractor?
DIY assembly is realistic for smaller metal buildings (typically under 30 feet wide and 40 feet long), provided you have mechanical aptitude, a crew of at least three to four people, and the right equipment. For larger structures, professional erection crews are strongly recommended and often required by building permit conditions.
DIY is reasonable if:
- The building is a small garage, shed, or storage structure.
- You have prior construction experience with framing and fasteners.
- Your local permit does not require a licensed contractor for erection.
- You have access to a forklift or telehandler for setting rigid frames.
Hire a contractor if:
- The building exceeds 40 feet in width or has complex roof lines.
- Your local building department requires licensed contractor sign-off.
- The site has challenging access, slope, or soil conditions.
- You are building for commercial or occupancy use.
💡 Practical note: Even experienced DIYers frequently hire a professional crew for the main frame erection and handle interior finishing themselves. This hybrid approach saves money while reducing the risk of structural errors.
What Permits and Zoning Issues Should I Know About Before Starting?
Permits and zoning are the most overlooked part of what I wish I knew before building a metal building. Most jurisdictions require a building permit for any permanent structure, and zoning rules can restrict metal buildings based on appearance, use, or location — even in rural areas.
Key zoning and permit questions to answer before ordering:
- Is the parcel zoned for the intended use? Agricultural, commercial, and residential zoning all carry different rules.
- What are the setback requirements? Most counties require structures to be a minimum distance from property lines, roads, and other buildings.
- Are there aesthetic or material restrictions? Some HOAs and planned communities prohibit exposed metal siding.
- What wind and snow load certifications does the building need? Your supplier needs these specs to engineer the kit correctly.
- Is an engineered stamped drawing required? Many jurisdictions require a licensed structural engineer to stamp the plans before issuing a permit.
- Are there height restrictions? Agricultural areas often allow taller structures, but suburban zones may cap building height at 20–35 feet.
Pro tip: Call your county planning and zoning office before you do anything else. A 20-minute conversation can save months of delays and thousands of dollars in redesign costs.
How Long Do Metal Buildings Really Last Compared to Traditional Construction?
A properly constructed metal building lasts 40 to 60 years with routine maintenance, and many commercial steel structures have exceeded 80 years of service life. This compares favorably to wood-frame construction, which typically carries a practical lifespan of 30–50 years before major structural repairs become necessary.
Longevity comparison:
| Structure Type | Expected Lifespan | Key Vulnerability |
|---|---|---|
| Prefab metal building | 40–60+ years | Surface rust if coating is damaged |
| Wood-frame building | 30–50 years | Rot, termites, moisture damage |
| Pole barn | 20–40 years | Post rot at ground contact points |
| Concrete block | 50–100+ years | Cracking, rebar corrosion |
Steel’s primary enemy is corrosion. Modern Galvalume and Galvanized steel coatings, combined with quality paint systems, provide strong corrosion resistance. Buildings in coastal or high-humidity environments need more frequent inspection and may benefit from additional protective coatings.
What’s the Difference Between Pole Barns and Prefab Metal Buildings?
A pole barn uses wood or steel posts buried in the ground as its primary structural support, while a prefab metal building uses a bolted steel rigid frame anchored to a concrete foundation. These are fundamentally different structural systems with different cost profiles, lifespans, and appropriate uses.
Key differences at a glance:
- Foundation: Pole barns require no concrete slab (posts go into the ground). Metal buildings require a concrete foundation or engineered pier system.
- Cost: Pole barns are generally cheaper upfront — often 20–40% less than a comparable metal building — but have higher long-term maintenance costs due to post rot.
- Lifespan: Pole barns typically last 20–40 years. Metal buildings last 40–60+ years.
- Permits: Metal buildings are more likely to meet commercial building code requirements. Pole barns may not qualify for certain occupancy classifications.
- Customization: Prefab metal buildings offer more precise engineering for wind and snow loads, making them better suited for high-load environments.
Choose a pole barn if: you need a low-cost agricultural storage structure quickly and long-term permanence is not a priority.
Choose a prefab metal building if: you need a structure that meets commercial codes, will be used for occupancy, or needs to last several decades with minimal structural maintenance.
Are Metal Buildings Good for Workshops, Garages, and Everyday Use?
Metal buildings are an excellent choice for workshops, garages, agricultural storage, and light commercial use. They are not limited to industrial applications — in 2026, metal buildings are commonly used for home gyms, hobby shops, equestrian facilities, retail spaces, and even residential homes.
Best uses for metal buildings:
- Workshops and garages: Clear-span interiors (no interior columns) make metal buildings ideal for vehicle storage and large equipment.
- Agricultural: Hay storage, equipment sheds, and livestock facilities benefit from metal’s durability and low maintenance.
- Commercial: Retail, warehousing, and light manufacturing are classic metal building applications.
- Residential: Barndominium-style metal homes are a growing trend, combining residential living space with workshop or garage areas under one steel roof.
Where metal buildings are less ideal: Structures requiring heavy acoustic insulation, highly complex architectural forms, or locations with strict aesthetic codes may be better served by other construction methods.
What Kind of Foundation Do I Need for a Metal Building?
Most metal buildings require a concrete slab or perimeter foundation engineered to match the building’s anchor bolt pattern and load specifications. The foundation is not a generic product — it must be designed specifically for your building’s dimensions, weight, and local soil conditions.
Common foundation types:
- Monolithic concrete slab: The most common choice for garages, workshops, and small commercial buildings. The slab and footings are poured as one unit.
- Perimeter foundation with interior gravel: Used when a full slab is not needed (agricultural storage, for example). Reduces concrete cost but limits interior use.
- Pier foundation: Used on sloped sites or in areas with expansive soils. Requires more engineering but can be cost-effective in the right conditions.
- Engineered fill slab: Required when native soil has poor bearing capacity. Adds cost but ensures structural integrity.
⚠️ Critical: Your metal building supplier will provide an anchor bolt layout drawing. This drawing must go to your concrete contractor before the slab is poured. Anchor bolts set in the wrong position cannot be easily corrected and can require breaking out and reporing sections of concrete.
How Do Metal Building Prices Compare to Wooden Structures, and What Unexpected Costs Should I Budget For?
Metal buildings and wood-frame buildings have comparable all-in costs at the mid-range, but metal buildings tend to offer better long-term value due to lower maintenance costs and longer lifespan. For a basic 2,400 sq. ft. structure, wood-frame construction typically runs $45–$85 per square foot all-in, while a metal building runs $35–$70 per square foot — giving metal a modest upfront advantage that grows over time.
Unexpected costs that catch first-time builders off guard:
- Delivery surcharges: Long steel panels require specialized flatbed transport. Delivery fees of $1,500–$5,000 are common, and remote sites pay more.
- Site preparation: Clearing, grading, and compacting the building pad can cost $3,000–$15,000 depending on site conditions.
- Engineering and stamped drawings: Required by most jurisdictions, these add $1,500–$5,000 to the project.
- Electrical and plumbing rough-in: Not included in any kit price. Budget $5,000–$20,000+ depending on complexity.
- HVAC: A 2,400 sq. ft. workshop or garage will need heating and cooling. Mini-split systems, radiant heat, or forced air all add $3,000–$15,000.
- Interior finishing: Liner panels, drywall, flooring, and lighting can double the cost of a basic shell.
- Crane or equipment rental: Setting large rigid frames requires a crane or telehandler. Rental runs $500–$2,000 per day.
What Maintenance Does a Metal Building Require Over Its Lifetime?
Metal buildings require significantly less maintenance than wood-frame structures, but they are not maintenance-free. Annual inspections and minor preventive work are the key to achieving the full 40–60 year lifespan.
Annual maintenance checklist:
- Inspect roof panels and ridge cap for loose fasteners or cracked sealant.
- Check all door and window trim for gaps or separation.
- Clear gutters and downspouts of debris.
- Inspect the base trim and foundation line for standing water or soil buildup against the steel.
- Touch up any paint chips or scratches with manufacturer-matched coating to prevent rust.
- Check interior insulation for moisture or compression.
Every 5–10 years:
- Reapply sealant at all penetrations (vents, electrical conduit, HVAC).
- Inspect fastener integrity on roof and wall panels.
- Consider a full exterior wash to remove oxidation and biological growth.
The biggest long-term threat to a metal building is water infiltration at penetrations and trim joints — not the steel panels themselves. Address small leaks immediately, because water trapped behind panels accelerates corrosion significantly.
Are Metal Buildings Energy Efficient and Good for Saving on Utilities?
A well-insulated metal building can be highly energy efficient, but the bare steel shell is one of the least energy-efficient structures possible. The building’s thermal performance depends almost entirely on the insulation system installed, not the steel itself.
Insulation options and their impact:
- Fiberglass blanket insulation (most common): Cost-effective and widely available. Achieves R-13 to R-19 in walls and R-19 to R-30 in roofs. Adequate for most climates.
- Spray polyurethane foam (SPF): Higher R-value per inch, eliminates air gaps, and doubles as a vapor barrier. Best choice for cold or high-humidity climates. Costs 2–3x more than fiberglass.
- Rigid board insulation: Used in combination with other systems for enhanced thermal performance in commercial applications.
Energy efficiency tips specific to metal buildings:
- Install reflective radiant barrier under the roof panels to reduce solar heat gain.
- Specify insulated doors — standard steel doors have poor thermal performance.
- Use thermal break framing at windows and doors to prevent cold bridging.
- Orient the building to minimize west-facing glazing in hot climates.
A properly insulated metal building can meet or exceed the energy performance of a wood-frame structure of the same size, according to the Metal Building Manufacturers Association (MBMA).
Frequently Asked Questions
Q: What is the minimum size metal building worth buying from a prefab supplier?
Most prefab metal building suppliers have minimum order sizes around 12×20 feet. Below that threshold, a pre-engineered shed kit or custom fabrication is usually more cost-effective.
Q: Do I need an architect for a metal building?
Not always. Many suppliers provide engineered drawings as part of the kit package. However, if your jurisdiction requires a licensed architect’s stamp or if the building includes occupancy space (offices, living quarters), an architect may be required.
Q: How long does it take to build a metal building from order to completion?
From order placement to move-in, expect 4–6 months for a straightforward project: 6–12 weeks for kit manufacturing and delivery, plus 4–12 weeks for site prep, foundation, and erection depending on complexity and contractor availability.
Q: Can a metal building be expanded later?
Yes, most prefab metal buildings are designed to be expandable. Endwall extensions are the easiest addition. Sidewall additions require more structural work. Plan for future expansion at the design stage by specifying expandable endwalls upfront.
Q: Are metal buildings loud in rain and hail?
Without insulation, yes — rain on a metal roof is noticeably loud. With proper insulation installed (especially spray foam or thick fiberglass blanket), noise is reduced to levels comparable to a conventional building.
Q: What is the best steel gauge for a residential or workshop metal building?
For most residential and light commercial applications, 26-gauge steel panels are standard. 24-gauge offers better dent resistance and is worth the modest upcharge for roofing in hail-prone areas.
Q: Do metal buildings rust?
Modern metal buildings use Galvalume or galvanized steel with a factory-applied paint system that provides strong corrosion resistance. Rust typically only occurs at cut edges, fastener points, or areas where the coating has been mechanically damaged and left untreated.
Q: Can I finance a metal building like a traditional home?
Financing options vary. Agricultural and commercial metal buildings can often be financed through farm credit lenders, SBA loans, or equipment financing. Barndominiums used as primary residences may qualify for conventional or USDA mortgage products depending on local appraisal standards.
Q: What wind speed ratings should I look for in a metal building kit?
Most standard kits are engineered for 90–110 mph wind exposure. In hurricane-prone coastal areas (Florida, Gulf Coast, Carolinas), specify 130–150 mph or higher. Always confirm the wind speed requirement with your local building department before ordering.
Q: Is a metal building a good investment for resale value?
A well-built, properly permitted metal building adds measurable value to a property, particularly for agricultural and light commercial real estate. Unpermitted or poorly finished structures can actually reduce appraisal value. Always pull permits.
Conclusion: What I Wish I Knew Before Building a Metal Building — Your Action Plan
Reflecting on everything covered here, the single most important thing I wish I knew before building a metal building is this: the kit price is not the project price. Every decision downstream of that misunderstanding — from undersized budgets to skipped permits — flows from that one false assumption.
Your actionable next steps before breaking ground:
- Call your county planning office and confirm zoning, setback rules, and permit requirements before ordering anything.
- Build a complete project budget using the cost table in this guide as a starting framework. Add a 15–20% contingency for unknowns.
- Get at least three quotes from reputable metal building suppliers and compare them on the same specs: gauge, insulation package, trim, and engineering drawings.
- Hire a local geotechnical or civil engineer to assess your site if you have any uncertainty about soil bearing capacity or drainage.
- Decide on your insulation system early — it affects the building’s structural details and must be specified before manufacturing.
- Size up by 20% from your current estimate. Nearly every metal building owner wishes they had built larger.
- Verify contractor credentials — ask for proof of insurance, references from similar projects, and confirm they have experience with your specific building system.
Metal buildings are one of the most cost-effective, durable, and flexible construction options available in 2026. With proper planning, the right team, and a realistic budget, they deliver exceptional long-term value. The goal of this guide is to make sure you walk into that process with clear eyes — and come out with a building you are proud of for decades to come.
References
- Metal Building Manufacturers Association (MBMA). Metal Building Systems Manual. MBMA, 2021. https://www.mbma.com
- RS Means / Gordian. Building Construction Cost Data. Gordian, 2023. https://www.gordian.com/rsmeans
- International Code Council (ICC). International Building Code (IBC). ICC, 2021. https://www.iccsafe.org
- U.S. Department of Energy. Building Energy Codes Program: Climate Zones and Insulation Requirements. DOE, 2022. https://www.energycodes.gov
- American Institute of Steel Construction (AISC). Steel Construction Manual, 16th Edition. AISC, 2023. https://www.aisc.org
